How To Open A Float Spa In 6 Months And Reach First Bookings
Float Spa
You’re opening a saltwater float spa, so the launch plan has to line up tanks, lease work, permits, sanitation, staffing, booking, and pre-sales before the first paid session This 5-year planning case uses 4 float tanks, a 6-month buildout path, 15 average daily visits in Year 1, and a Month 6 breakeven target Your next step is to map each opening task to the lease, tank delivery, inspection, and cash runway timeline
Time to Open6 monthsLaunch runwayLaunch Sequence8 stagesValidate firstKey BottleneckBuildout delayLead timeFirst Revenue StepSoft launch salesBooking live
Launch timeline
This is a short web summary of the launch plan, and the XLSX export has the detailed Gantt chart.
First customers for a Float Spa should come before the grand opening: open soft-launch booking once tank testing, waivers, sanitation logs, and staff scripts are ready, then sell intro floats, founder memberships, packages, gift cards, referrals, and local wellness partnerships. The first revenue target is paid appointments, not broad awareness, and the pricing mix should start with $95 single floats, $80 packages, $65 monthly memberships, $30 retail products, and $8 add-ons; see How Much Does It Cost To Open Float Spa? for the setup side.
Pre-open sales
Start booking before opening day
Offer intro floats early
Sell founder memberships fast
Push gift cards and packages
Track early demand
Count booked visits per tank
Watch no-shows closely
Measure package conversion
Track membership starts weekly
What do you need to open a float spa?
To open a Float Spa, validate demand and pricing first, then line up the site, tanks, permits, staff, and booking systems in operating order. Year 1 planning should model 15 visits per day across 310 operating days, or 4,650 visits, with customer satisfaction tracked through What Is The Most Important Indicator Of Customer Satisfaction For Float Spa?.
Build the base
Validate demand and local pricing
Plan for 4 tanks
Secure drainage, electrical, HVAC
Confirm humidity control and ADA access
Open in order
Order tanks in Months 1–3
Finish buildout in Months 1–4
Install filtration in Months 2–4
Launch booking, payments, memberships
What float spa launch mistakes create the most risk?
The biggest launch risk for a Float Spa is spending on buildout before the site is proven and then running a weak operating system. Confirm drainage, electrical, ventilation, ADA access, landlord approval, and inspections before final equipment orders, then lock in filtration, water testing, salt management, cleaning logs, and customer hygiene instructions. Train staff to explain the float process, calm first-time guests, clean rooms, sell memberships, and handle payment issues, and use pre-sales before Month 6; the model check uses 15 daily Year 1 visits.
Buildout and sanitation risks
Check drainage before ordering tanks.
Verify electrical and ventilation early.
Get landlord approval and inspections first.
Use filtration, testing, and cleaning logs.
Staffing and demand risks
Train staff on the float process.
Calm first-time guests fast.
Push memberships and handle payments.
Run pre-sales before Month 6.

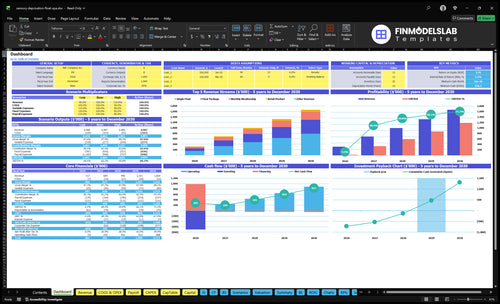

Float Spa Financial Model
5-Year Financial Projections
100% Editable
Investor-Approved Valuation Models
MAC/PC Compatible, Fully Unlocked
No Accounting Or Financial Knowledge
Confirm what must be complete before the float spa opens
Launch readiness checklist
Use this go-live approval checklist before opening to confirm the Float Spa is ready for launch.
1Compliance
Entity formed and bank openCritical
You need a legal entity and bank account before contracts, payroll, and payments start.
Local permits and zoning clearedCritical
The site must be allowed for float tanks, public use, and the planned buildout.
Insurance policy boundCritical
Coverage should be active before guests enter the facility or staff start work.
2Site
Drainage and humidity approvedCritical
Water-filled tanks need safe drainage, ventilation, and humidity control before opening.
Occupancy and signage clearedHigh
The space must pass occupancy rules and allow required exterior signage.
Guest access routes readyHigh
Guests need clear entry, check-in, and room access for a smooth first visit.
3Systems
Four tanks installedCritical
The model assumes four floatation tanks, so all units must be live before launch.
Filtration and sanitation liveCritical
Water treatment must run cleanly to protect guests and avoid shutdown risk.
Water test logs readyCritical
Daily logs show the saltwater stays within safe operating limits.
4Team
Manager hired and scheduledHigh
A manager needs clear ownership of opening day, service flow, and issue handling.
Client flow trainedHigh
Front-line staff must know check-in, room turns, guest guidance, and cleanup steps.
Technician SOPs signed offCritical
Standard operating procedures keep water care, cleaning, and safety work consistent.
5Booking
Booking system liveCritical
The site needs a working path for guests to book without staff help.
Payments tested end to endCritical
Payment flow must work before launch so sales can settle without delay.
Waivers approved by counselHigh
Waivers and intake forms should be reviewed before the first guest signs in.
6Finance
Cash covers Month 6Critical
The model shows minimum cash of $256,000 in Month 6, so runway must cover that dip.
Hit 15 daily visitsCritical
Year 1 assumes 15 visits a day, which supports the Month 6 breakeven path.
Retail stock stagedMedium
Initial retail inventory should be on hand for add-on sales in the first month open.
Which six launch drivers matter most?
1Location Fit
Month 1-4
Signed lease, HVAC, drainage, and ADA access decide whether heavy tanks can open on schedule.
2Tank Install
4 tanks
Four tanks and room fit must line up before testing, or first bookings get pushed back.
3Water Safety
Month 2-4
Water treatment and cleaning logs need to work on day one, or trust and repeat visits drop fast.
4Compliance
License gate
Local permits, insurance, and waivers need clear approval first, or the opening stalls at inspection.
5Staff Training
1.0 FTE
Trained staff keep floats calm, clean, and on time, which protects reviews and package sales.
6Demand Gen
Pre-booked
Pre-booked sessions before launch create early cash and show demand before soft-opening slots fill.
Location And Buildout Fit
Lease-Ready Space
A float spa only opens on time if the signed lease supports heavy water-filled tanks, private rooms, drainage, electrical capacity, ventilation, humidity control, ADA access, parking, signage, and inspection work. The setup assumes $150,000 in leasehold improvements from Month 1 to Month 4 plus a $20,000 HVAC upgrade from Month 1 to Month 3.
The real risk is a cheap space that looks fine on paper but fails floor, utility, or humidity needs. Here’s the quick math: if the landlord blocks waterproofing, shower placement, or guest flow changes, you lose time on redesign and inspection fixes before the first float is ever sold.
Check The Building Before You Sign
Start with landlord approval, then review the floor load, plumbing, power, and ventilation before you lock the lease. A space that can’t handle water, steam, and privacy will slow tank installation and push back opening work. That’s the launch gate.
Sequence the buildout in this order: room layout, waterproofing, shower placement, laundry area, and guest flow. Verify the space can pass inspections with fewer changes later. Keep a written list of each requirement and get it signed off before paying for improvements.
Confirm floor and utility capacity
Map tank and room layout
Plan waterproofing and showers
Check HVAC and humidity control
Document ADA and parking access
1
Tank Procurement And Installation
Tank Procurement And Installation
The spa cannot test or serve guests until the tanks are in, powered, and linked to the rooms. In this plan, 4 floatation tanks cost $400,000 and are staged from Month 1 to Month 3, so this sits on the critical path. If the tanks show up before the rooms, drains, electrical work, or HVAC are ready, opening slips and first bookings get canceled.
Here’s the quick math: tank delivery, room fit, electrical connections, and filtration tie-ins all have to line up before soft opening. That means vendor lead time, access routes, room dimensions, and staff training are not side tasks; they’re launch gates. When this runs right, the spa opens cleaner, tests earlier, and starts day one with working rooms instead of broken promises.
Control the install sequence
Lock the vendor, then lock the room. Confirm lead time, deposit timing, and delivery access before you schedule installation dates. Test every tank after power, drains, HVAC, and filtration are in place, and train staff on maintenance and backup support contacts before the first guest books. That keeps the launch real, not theoretical.
Use a tight checklist so nothing moves out of order:
Confirm vendor lead time
Match tank size to room dimensions
Verify electrical and filtration tie-ins
Schedule delivery before install
Run system testing early
Train staff on upkeep
Save backup support contacts
What this estimate hides is simple: if any one of those pieces lands late, the whole opening date moves. A clean install lowers the chance of a rough soft opening and helps avoid canceled first bookings.
2
Water Sanitation And Safety Systems
Water Safety Readiness
Water sanitation is a day-one trust issue for a float spa. Guests are lying in private tanks, so the business needs active filtration, water testing, salt management, disinfection, and incident response before the first booking. The plan already includes $45,000 for advanced water filtration from Month 2 to Month 4, so any delay here can push opening and trigger early complaints.
Here’s the quick math: Year 1 direct costs include 15% for Epsom salt and water treatment plus 8% for cleaning agents and supplies. That only works if staff follow SOPs (standard operating procedures), test logs, and room-turnover timing every shift. If the spa opens before those routines are repeatable, water quality becomes a cash and reputation problem on day one.
Lock the cleaning routine before opening
Before launch, verify the full chain: filtration is running, water tests are scheduled, salt is stocked, cleaning supplies are ordered, and staff know the disinfection steps. Put the work into written SOPs, staff checklists, and incident-response steps so the same process runs every time. One clean room is not enough; the process has to work across every session.
Set room-turnover timing targets.
Document client hygiene instructions.
Track every test in logs.
Set supply reorder points early.
Train staff on spill and incident steps.
Use a soft-opening checklist to test real turnover speed before the first paid guests. If cleaning takes too long or logs are missing, bookings slip and complaint risk rises. Don’t open until the water system, staff checklist, and supply backup all hold up under live use.
3
Compliance, Insurance, And Waivers
Permits, Insurance, And Waivers
Float spa launch readiness starts with local approval, not buildout. Permits can change by city, county, and state, so the space should not be locked until business license, zoning, building permits, health department expectations, occupancy approval, and signage approval are clear. If you assume standard spa rules, you can finish the build and still miss opening day.
Here’s the quick math: the model carries $750/month for liability insurance and $400/month for professional fees, or $1,150/month before local filing costs. That spend only helps if it clears the legal path to open. Missing waiver language, intake forms, or tax setup can block day-one check-in, delay first revenue, and raise liability exposure before the first guest arrives.
Verify Local Rules Before You Build
Start with local agencies and document every requirement before you buy or install anything. The goal is a clean readiness file with each approval, inspection step, and lease duty mapped out. If the lease blocks plumbing, occupancy, or signage, fix that now. If counsel needs to review waivers, do it before marketing starts. One missed permit can push the opening date by weeks.
Call city, county, and state offices.
Write down inspection steps.
Review lease and use limits.
Set waiver language with counsel.
Confirm payment and tax setup.
Track readiness by status, not hope: approved or pending for each item. If occupancy, insurance, or customer waiver review is still open, the spa is not launch-ready, even if the tanks are installed and the rooms are finished.
4
Staff Training And Guest Experience
Staff Readiness
The spa can’t open on time if the guest-facing team isn’t ready to run the first visit end to end. A float room may be built, but day one still needs staff who can greet first-time guests, explain the float process, calm anxiety, process payments, and handle booking issues without slowing the schedule.
Year 1 staffing includes 10 spa manager, 10 client experience specialist, and 075 float technician. Training should cover scripts, sanitation, room-turnover checklists, escalation steps, and mock appointments; otherwise, the bottleneck shifts from equipment to people, and that shows up as bad reviews, weaker package conversion, and messy scheduling in the first operating month.
Pre-Open Training Checklist
Lock the service flow before the first booking goes live. Every new hire should practice the same intake, room reset, and closeout steps so the guest experience feels calm and repeatable. One weak handoff can break the premium feel fast.
Test first-guest scripts.
Run mock appointments.
Check room-turnover timing.
Train payment and booking fixes.
Practice membership offers.
Assign escalation owners.
If training slips, the spa may still open, but staff will learn on live guests, and that raises complaint risk, slows turns, and makes early revenue less predictable.
5
Pre-Opening Demand Generation
Booked Demand Before Opening
This launch driver matters because a float spa needs paid bookings before the first day to avoid opening to an empty calendar. The readiness signal is a live booking calendar backed by soft-opening appointment blocks, a local search profile, and an intro offer that turns interest into deposits or scheduled sessions.
With Year 1 pricing at $95 per single float, $80 per package visit, $65 per membership visit, plus $30 retail and $8 add-ons, early demand also shapes cash needs. Year 1 marketing and advertising is modeled at 50% of revenue, so waiting until grand opening to test demand can leave you with higher spend and slower membership ramp.
Pre-Sell Before You Unlock Doors
Build the pre-sale engine first: landing page, email list, gift card setup, referral offer, founder memberships, and a wellness partner list. Get the local search profile live early, then book soft-opening slots so you can test pricing, no-show behavior, and service flow before full launch. Simple rule: if the calendar is still blank, the market is not ready yet.
Publish the landing page first.
Set the no-show policy in writing.
Load gift cards before outreach.
Track partner leads by source.
Hold back slots for soft opening.
What this hides is timing risk: if partner outreach or review plans slip, you may open with no proof of demand and no early cash. That makes staffing, inventory, and ad spend harder to pace in month one.
Start with site feasibility, not decor Confirm the space can handle 4 tanks, drainage, electrical load, HVAC, humidity control, and inspections This planning case uses a 6-month setup, 15 Year 1 daily visits, and 310 operating days Then line up permits, insurance, sanitation SOPs, staff training, booking, and pre-sales
Plan for 4 to 8 months The researched case stages tanks from Month 1 to Month 3, leasehold work through Month 4, and booking hardware plus retail inventory in Month 6 The schedule can slip if landlord approval, HVAC, water filtration, inspections, or staff training are not ready together
Yes, but the exact permits depend on your US city, county, and state Check business licensing, zoning, building permits, occupancy, signage, health department expectations, and sales tax setup This model also includes liability insurance at $750 per month and professional fees at $400 per month to support compliance readiness
Buildout and tank readiness cause the biggest delays Watch floor load, tank delivery access, drainage, waterproofing, electrical capacity, HVAC, humidity control, and water filtration In this plan, filtration runs Month 2 to Month 4, HVAC runs Month 1 to Month 3, and breakeven is targeted for Month 6
Sell appointments before the grand opening Use $95 single floats, $80 packages, $65 memberships, gift cards, and soft-opening sessions to test demand The Year 1 plan assumes 40% single sessions, 30% packages, 20% memberships, and 10% ancillary sales, so early booking mix matters as much as total traffic
About the author
Ethan Carter
Founder-Focused Content Writer
Ethan Carter is a founder-focused content writer at Financial Models Lab, specializing in business expense analysis and what it really costs to operate a startup. He writes practical founder checklists for people starting with limited capital, helping them plan realistically before money is invested and connect business ideas with workable startup budgets.
Choosing a selection results in a full page refresh.
