What hidden costs of starting a cable TV company should be funded?
For a Cable TV Service Provider, the hidden costs are not the boxes and lines; they are municipal franchise work, FCC compliance, legal review, engineering consultants, pole attachment coordination, make-ready delays, insurance, callbacks, failed installs, customer support setup, billing setup, and content minimum guarantees. If you want the plain math on margin pressure, see How Increase Profits Cable TV Service Provider? and plan around $263k/month fixed overhead, $25M Year 1 marketing, $180 CAC, and Year 1 payroll of $4611M. Even after launch revenue starts, the modeled cash trough still reaches -$15759M in Month 32, so these costs need funding up front.
Fund these first
Pay franchise and permit work.
Cover FCC and legal review.
Budget pole and make-ready delays.
Fund content minimum guarantees.
Plan the burn
Carry $263k monthly overhead.
Fund $25M Year 1 marketing.
Assume $180 customer acquisition cost.
Keep cash through Month 32.
How much does it cost to start a cable TV company?
A modeled Cable TV Service Provider needs $716M in startup CAPEX from Month 1 to Month 12, but the real funding need is larger because cash bottoms at -$15,759M in Month 32; for KPI context, see What Are The 5 KPIs For Cable TV Service Provider Business?. Year 1 shows $6,746M revenue and -$5,734M EBITDA, so early scale still burns cash.
Base funding math

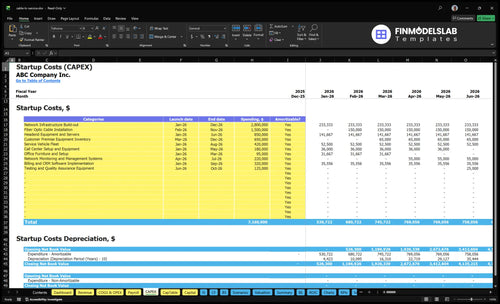

$716M startup CAPEX
Months 1–12 build spend
-$15,759M minimum cash position
Month 32 funding trough
Main cost drivers
Own or lease infrastructure
Increase homes passed
Improve service-area density
Set channel lineup costs
How should a cable TV provider business plan connect startup costs to financial projections?
For a Cable TV Service Provider, startup costs should feed the subscriber ramp, not sit beside it. Using the given mix, the weighted subscription price is about $74.49 per month from 45% Basic at $49.99, 35% Entertainment Plus at $79.99, and 20% Sports Premium at $119.99; the one-time fee mix is about $13,650 per new subscriber. Then test the plan against $25M Year 1 marketing, $180 CAC, churn, programming cost, depreciation, amortization, debt service, Year 1 EBITDA of -$5,734M, and Month 32 minimum cash of -$15,759M.
Revenue bridge
$74.49 weighted monthly price
45% Basic at $49.99
35% Entertainment Plus at $79.99
20% Sports Premium at $119.99
Runway test
$25M marketing at $180 CAC
About 138,889 new subs funded
Include programming and churn
Stress-test cash through Month 32
Calculate Fuding Needs
Startup cost summary
Summarizes cable TV startup CAPEX and excluded launch cash needs using researched low, base, and high scenarios.
Outside Plant and Network Infrastructure Startup Expense
Buildout scope
Network buildout is the main CAPEX line. Base cost is $28M from Month 1 to 12 for construction, coaxial and fiber plant, nodes, amplifiers, taps, drops, pole attachments, trenching, make-ready work, and route design. Add $15M for fiber installation from Month 2 to 11.
Size it right
Size this from miles of plant, homes passed, aerial versus underground mix, required upgrades, and expected subscriber penetration. Here’s the quick math: engineering quotes and service-area maps should drive the unit cost, then you phase spending by month instead of using a flat estimate.
Miles of plant
Homes passed
Aerial versus underground mix
Keep OPEX out
Do not mix this with operating expense. Monthly maintenance sits separately at $125k per month, so the buildout budget stays clean and launch cash stays readable. One line funds the asset build; the other covers ongoing upkeep after go-live.
Track CAPEX by work package
Book maintenance in OPEX
Update for upgrade scope
Cash plan
For launch planning, treat $43M as the base capital starting point before location-specific adjustments. Dense service areas and more aerial work can lower trenching and make-ready spend; more underground plant pushes cash need higher. Keep the spend tied to the construction calendar from Month 1 to 12.
Headend and Signal Processing Startup Expense
Headend CAPEX
$850k covers the launch headend build: encoders, modulators, receivers, servers, monitoring, backup power, technical room setup, physical security, and signal quality controls from Month 1 to Month 6. This is core technical CAPEX, so it belongs in startup cash, not operating expense.
Budget Build
Add $220k for network monitoring and management systems from Month 4 to Month 7, plus $125k for testing and quality assurance equipment from Month 6 to Month 10. Here’s the quick math: launch systems spend totals $1.195M before maintenance. Tie each quote to scope and coverage months.
Match spend to install milestones.
Use vendor quotes, not estimates.
Keep maintenance outside CAPEX.
Keep It Lean
One line: buy for launch quality, not for future growth. To reduce waste, standardize the technical room, phase noncritical tools later, and only buy test gear that fits the channel stack. Maintenance and software support should stay in operating costs, not this startup line.
Cash Timing
This spend is front-loaded across Month 1 to Month 10, so cash planning should follow build milestones, not revenue timing. The main mistake is mixing in ongoing support or buying monitoring and test gear too early. Keep software support in operating expense and verify every vendor quote against delivery month.
Customer Equipment and Installation Readiness Startup Expense
Launch gear
Size this cost to opening subscribers, not the full market. The launch pool is $650k for customer-premises gear from Month 3 to 12, plus a $420k service-vehicle fleet from Month 1 to 8. Here’s the quick math: equipment per active customer = $650k ÷ opening subscribers, with spare boxes, remotes, smart cards, kits, tools, and ladders inside that buffer.
What it covers
This bucket covers set-top boxes, remotes, cable modems if bundled, smart cards, installation kits, meters, ladders, tools, spare stock, and vehicles. Build it from unit count × unit price, then spread delivery across Month 3 to 12. The $650k figure only works if it matches first-wave demand and a spare inventory buffer for replacements and missed installs.
Fleet and labor
Keep the fleet lean. The $420k vehicle spend runs from Month 1 to 8, but operating drag continues with $28k per month for fuel and maintenance. Installation contractor costs sit at 35% of Year 1 revenue, so faster self-install and tighter routing matter most when launch volume is still small.
Cash control
Use active homes as the control point, not total serviceable homes. If installs slip, spare inventory and vehicles tie up cash fast; if contractors do too much work, cost rises because their fees are pegged to 35% of Year 1 revenue. Review equipment per active customer every month and keep a separate replacement buffer.
Programming and Content Rights Startup Expense
Rights, not buildout
Keep programming and content rights separate from network CAPEX. This line covers channel carriage fees, agreement deposits, minimum guarantees, legal review, lineup strategy, retransmission terms, and early subscriber assumptions. It hits gross margin and pre-opening cash, so deposits and minimums belong in funding needs, not in plant and equipment.
How to size it
Model content licensing and programming costs at 120% of Year 1 revenue, then 115%, 110%, 105%, and 100% in Years 2 to 5. Here’s the quick math: the driver is subscription revenue, plus package mix and expected subscriber count. Sports Premium should hold 200% of sales mix across the model period.
How to control it
Tie lineup choices to what customers buy, not to wishful demand. Keep premium sports in the mix only if the package mix can support it, and stress-test retransmission costs before launch. The main mistake is undercounting early subscribers, which makes rights fees look smaller than they really are and squeezes cash fast.
Use actual package mix.
Test low-subscriber cases.
Track deposits as cash needs.
Cash cover first
Programming agreements often need upfront deposits and minimum guarantees before revenue catches up. That means you need pre-opening cash cover, not just a CAPEX budget. If launch timing slips or subscriber counts lag, these rights costs still come due, so keep them in working capital planning from day one.
Regulatory, Software, and Launch Operations Startup Expense
Launch readiness
Treat this as systems-readiness, not admin. The launch stack covers municipal franchise work, legal and engineering consultants, insurance, customer relationship management (CRM) setup, billing and conditional access integration, customer support, launch marketing, and office readiness. Base costs include $320k for billing and CRM software implementation, $180k for call center setup, and $95k for office furniture and setup.
Cost build
Price this by workstream, then add the months needed to reach go-live. Use vendor quotes for software, hardware, and room buildout; then layer in the operating anchors at $18k per month for insurance and legal compliance and $35k per month for software licensing and IT systems. That is $53k per month, or $636k a year.
Quote each system separately
Track months of coverage
Keep integration testing visible
Trim risk
Cut waste by phasing the launch, but do not skimp on compliance or billing integration. The best savings come from sizing call center seats, support tools, and office buildout to live subscriber targets, not to a future dream state. A one-line check: if the service cannot handle install, billing, and support on day one, the cut was too deep.
Stage spend by launch date
Match support to live demand
Protect core controls first
Launch cash
Launch marketing starts at $25M in Year 1, so this is the biggest cash pull in the setup plan. Keep it separate from overhead and fund it as part of the go-to-market budget. If launch slips, the spend still burns, which means timing matters as much as the budget itself.
Compare 3 Startup Cost Scenarios
Startup cost scenarios
Scale changes fast here because plant miles, homes passed, and launch subscribers drive build cost and cash burn. Lean, Base, and Full show how a narrower launch can cut upfront capital.
Lean, Base, and Full launch cost bands for cable service build-out.
Scenario
Lean LaunchLimited local launch
Base LaunchNeighborhood buildout
Full LaunchRegional expansion
Launch model
Use leased infrastructure and a limited-area launch with a smaller headend and narrower channel lineup.
Use the researched build plan with full launch marketing, standard payroll, and a single-area service footprint.
Use multi-area network expansion with broader programming and a larger service footprint.
Typical setup
Keep customer equipment inventory low and start with a lean install and support team.
Fund the $7.16M CAPEX plan, $2.5M Year 1 marketing, $4.611M Year 1 payroll, and $263k monthly fixed overhead.
Carry more customer equipment, a larger vehicle fleet, and higher working capital for rollout and support.
Cost drivers
Leased plant
smaller headend
narrow channel lineup
lower equipment inventory
smaller launch team
Network build-out
Year 1 marketing
payroll
headend and systems
installer and customer equipment
Multi-area build-out
broader programming
larger fleet
more customer equipment
higher working capital
Planning rangeCAPEX only
$3M - $6MLower cash need
$15M - $18MModel-based range
$22M - $30MHigher cash need
Best fit
Best for teams testing one local market before a wider build-out.
Best for operators planning a full neighborhood launch with model-backed staffing and spend.
Best for teams expanding across several service areas at once.
!
Planning note: These ranges use researched planning assumptions from the model; they are not vendor quotes or fixed bids.
The researched base case uses $716M of startup CAPEX from Month 1 through Month 12 The largest pieces are $28M for network infrastructure buildout, $15M for fiber installation, and $850k for headend equipment and servers That amount does not include the full working capital need, which reaches a modeled -$15759M cash low in Month 32
In the base model, major infrastructure spending runs through the first year Network infrastructure buildout spans Month 1 to Month 12, fiber optic installation runs Month 2 to Month 11, and headend equipment and servers run Month 1 to Month 6 Billing and CRM implementation lasts through Month 9, so launch timing depends on both field construction and back-office readiness
Not always, but the cost answer changes fast if you don’t The base plan assumes owned or heavily built infrastructure, with $28M for network buildout and $15M for fiber installation A leased or upgraded network can lower upfront CAPEX, but it may shift costs into monthly access fees, margin pressure, and contract limits
Start with the channel lineup and subscriber forecast, then model programming as a revenue-linked cost plus any deposits or minimum guarantees In the source model, content licensing and programming costs equal 120% of Year 1 revenue, then step down to 100% by Year 5 Sports-heavy packages need extra care because Sports Premium is modeled at 200% of sales mix
The model does not provide a final break-even subscriber count, so calculate it from ARPU, margin, and fixed costs Year 1 weighted subscription price is about $7449 per month, while fixed overhead is $263k per month before payroll and marketing Year 1 EBITDA is -$5734M, so the early goal is cash runway first, then subscriber density
About the author
James Carter
Startup Guide Author
James Carter is a startup guide author at Financial Models Lab who focuses on startup budget assumptions for founders working with limited capital. He studies common expenses, revenue drivers, and launch requirements to help readers plan for rent, staff, equipment, and supplies. His small business startup guides connect business ideas with realistic startup budgets in a clear, practical way.
