What hidden costs of starting a hemp farm should founders budget for?
Industrial Hemp Farming hides most of its early cost in compliance and setup, not in seed alone. Budget for state or United States Department of Agriculture hemp licensing, background checks where required, THC sampling and testing, soil testing, crop insurance, legal setup, accounting, agronomy advice, recordkeeping, and labor before revenue starts; for a cash-flow view, see How Much Does The Owner Of Industrial Hemp Farming Typically Make?
The cash gap is the real trap: fiber, hurd, and biomass are modeled in month 8, grain in month 9, and sales can still take 4 to 8 months by crop type. So founders need working cash through harvest payment, not just CAPEX for land and equipment.
Pre-opening costs
Licensing before planting
Background checks where required
THC sampling and testing
Soil testing and agronomy advice
Cash gap items
Recordkeeping and accounting
Legal setup and crop insurance
Labor before revenue
Month 8 and month 9 harvest timing
How much does it cost to start a hemp farm?
To start Industrial Hemp Farming, don’t use one fake number; budget by operating model, and track growth with What Is The Current Growth Rate Of Your Industrial Hemp Farming Business?. In the base commercial case, 50 hectares with 20% owned land needs $222,000 for land control: $150,000 owned land CAPEX plus $72,000 first-year lease cash.
Base cost math
50 hectares equals about 123.6 acres
10 owned hectares at $15,000 each
40 leased hectares at $150/month
$222,000 before equipment and crop costs
Model drivers
Small pilot: prove yield and buyers
Base acreage: fund land control first
Mechanized setup: equipment ownership adds CAPEX
Irrigation, drying, harvest drive total funding
How do you estimate funding for a hemp farm?
A lender-ready funding estimate for Industrial Hemp Farming starts with CAPEX, pre-opening costs, and working capital, then ties acreage, harvest timing, operating expenses, and repayment capacity to the crop mix. Model 30% textile-grade fiber, 25% industrial-grade fiber, 25% hurd, 15% grain, and 5% biomass, with a 8% Year 1 yield loss and selling prices of $250, $180, $35, $220, and $20. Here’s the quick math: if harvest cash flow can still cover debt service after opex, the funding ask is more bankable.
Start with cash needs
Size CAPEX first
Add pre-opening costs
Fund working capital
Match cash to harvest timing
Build lender proof
Use the 30/25/25/15/5 crop mix
Apply 8% Year 1 loss
Model prices at $250 to $20
Show debt repayment capacity
Calculate Fuding Needs
Startup Cost Summary

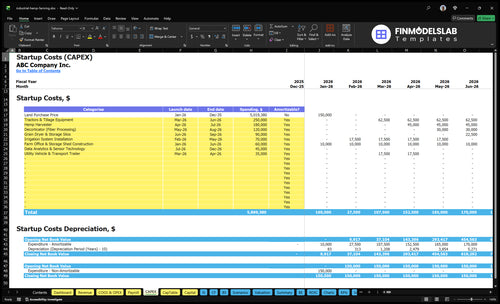

This table shows startup CAPEX and excluded cash needs for a 50-hectare industrial hemp farm.
Highlighted CAPEX$835,000Base planning example
Excluded cash needs$2,169,000Outside CAPEX total
Funding need$3,004,000CAPEX + excluded cash needs
Cost Category
Base Estimate
Main Cost Driver
CAPEX Calculator
Land Purchase
$150,000
10 owned hectares × land price per hectare
Yes
Machinery & Field Equipment
$285,000
Tractors, tillage gear, and utility transport
Yes
Harvest Equipment
$180,000
Hemp harvester for the first harvest cycle
Yes
Irrigation System
$70,000
Irrigation install across the cultivated area
Yes
Drying & Storage Infrastructure
$150,000
Grain dryer, silos, and storage shed buildout
Yes
Opening Cash Buffer
$2,169,000
Payroll, leases, compliance, and pre-revenue timing
No
Industrial Hemp Farming Core Five Startup Costs
Land And Site Preparation Startup Expense
Land Cost Base Case
For a 50-hectare base case, land access starts at $222,000: 10 owned hectares at $15,000 each = $150,000, plus 40 leased hectares at $150 per hectare per month for 12 months = $72,000. Keep land acquisition separate from field-readiness work like soil testing, drainage, fencing, access roads, water access, and basic utilities.
What It Covers
This cost covers the site itself, then the work to make it farm-ready: soil testing, amendments, drainage, field layout, access roads, fencing, water access, and basic utilities. The estimate needs hectares, ownership mix, purchase price, lease rate, and lease term. One clean rule: do not bundle land purchase with prep work.
How To Control Spend
Lease more acreage if you want to keep cash free, and buy only when location and tenure justify it. Get quotes for grading, fencing, roads, and utility hookups before you commit. Here’s the quick math: if a field fails drainage or access checks, the savings from cheap land can vanish fast.
Lease first, buy later
Price prep work separately
Test soil before grading
Field-Readiness Risk
Soil issues, poor drainage, and weak access can hurt planting and harvest timing. Build the budget around the field’s real condition, not a standard rate. If water access or basic utilities need upgrades, fund them early so the site can support stable hemp production without last-minute fixes.
Machinery, Equipment, And Irrigation Startup Expense
Farm Fleet
Owned machines are CAPEX: tractors, seed drills or planters, cultivation tools, sprayers, trailers, material handling, and harvest support assets. Budget with unit count × vendor quote, then split owned gear from leased or custom-hired gear so the startup plan shows what sits on the balance sheet and what runs through operating expense.
Cost Build
Use three inputs: how many units, how many months or field days, and which jobs stay seasonal. Buying turns into CAPEX; leasing, custom hiring, and equipment sharing go into OPEX. One line is enough: own the core fleet, rent the rest.
Count peak-season hours.
Quote lease and hire rates.
Tag shared gear by job.
Irrigation Spend
Irrigation covers pumps, lines, water access, and setup. In the first operating year, model it at 20% of revenue. Owned irrigation is CAPEX; water, pumping, repairs, and hired setup crews are OPEX, so the budget needs both lines.
Fuel and Power
Fuel and energy should be modeled at 25% of revenue in year one. Here’s the quick math: irrigation at 20% plus fuel and energy at 25% means 45% of sales is already tied to field operations before seed, labor, or overhead. Low-use machines are often cheaper to rent or share.
Seed, Planting Material, And Agronomic Inputs Startup Expense
Seed Anchor
Seed and nutrient spend is a major Year 1 field-start cost. Budget it at 70% of revenue, then size it by acres planted, certified seed or approved cultivars, seed rate, germination allowance, soil amendments, fertilizer, and early crop protection.
Cost Build
This cost covers seed lots, starter nutrients, and first-pass crop protection for 30% textile-grade fiber, 25% industrial-grade fiber, 25% hurd, 15% grain, and 5% biomass. The math is simple: acres x unit price, plus a germination buffer and replant reserve.
Ask for germination test data.
Match seed to crop line.
Separate seed and nutrient quotes.
Tighten Spend
Buy approved cultivars only, and price seed, fertilizer, and amendments separately. Use soil tests before you spread anything, so you do not overbuy nutrients. Keep early weed and pest control targeted. CBD clone economics is outside scope here.
Test soil before ordering inputs.
Confirm cultivar approval first.
Hold a small replant reserve.
Replant Risk
What this estimate hides is weather loss and weak emergence. If germination slips, the seed bill rises fast because you buy more seed and still carry fertilizer and crop protection on the extra acres. Build the allowance in up front, not after planting.
Licensing, Compliance, Insurance, And Professional Services Startup Expense
Licensing
Budget for state or United States Department of Agriculture hemp program licensing, plus background checks where required, sampling, THC testing, and recordkeeping. Fees and testing rules vary by state, so this is a regulated startup cost, not equipment CAPEX. Price it with license fees, field count, lot count, and test rounds.
Compliance
Build this line from quotes for legal, accounting, and agronomy support, plus crop insurance. Here’s the quick math: license fee + checks + samples × lab rate + advisor hours. Keep permits, test results, and field maps together, because weak records can trigger rework or delays.
Quote by state first.
Price each lot separately.
Track renewal dates.
Risk Plan
Use a Year 1 yield loss of 80% when you size insurance and working capital. That protects cash if sampling, weather, or compliance cuts output hard. It’s a planning input, not a forecast, and it should sit beside fixed costs you must still pay.
Policy Costs
Keep regulated startup spend separate from tractors, irrigation, and other CAPEX. That split makes lender talks cleaner and helps you compare states on true entry cost. If one state needs more sampling or stricter THC testing, the cash need rises even when equipment spend stays the same.
Harvest, Drying, Storage, And Post-Harvest Startup Expense
Harvest scope
Plan month 8 for textile-grade fiber, industrial-grade fiber, hurd, and biomass, then month 9 for grain. This cost covers harvest coordination, cutting, baling, grain handling, drying, storage, trailers, loading gear, and transport to processors or buyers. Budget to 80% of first-year revenue for harvesting and primary processing.
Cost inputs
Build the estimate from crop mix, harvest timing, and quotes for hauling, drying, and storage. Keep farm-level drying and storage separate from decortication and downstream plant costs. That avoids double counting and keeps the startup budget clean. One simple rule: if it happens before the processor gate, put it here.
Control the spend
Use custom crews, shared trailers, and rented storage when volume is light. Keep moisture control tight, because spoilage and rework raise this cost fast. The first-year benchmark is still 80% of revenue, so savings come from coordination and asset sharing, not from skipping drying or safe storage.
Keep it separate
Do not bundle farm drying and storage with decortication, textile, construction, or bioplastics facilities. Those are separate assets, and they need separate quotes, budgets, and financing. A clean split makes it easier to choose buy, lease, or custom-hire for each step.
Compare 3 Startup Cost Scenarios
Startup cost scenarios
Startup costs swing fast because land mix, machinery, and post-harvest gear drive most of the cash need. Lean keeps it lease-heavy; Full adds owned land, storage, drying, and mechanization.
Lean, Base, and Full launch cost comparison for industrial hemp farming
Scenario
Lean LaunchLowest cash risk
Base LaunchLender-ready base case
Full LaunchMechanized growth setup
Launch model
Use mostly leased land and custom-hired field work to keep upfront cash low.
Run 50 hectares with 20% owned land, $150,000 land CAPEX, and $72,000 first-year lease cash.
Add more owned land, mechanization, irrigation, storage, and drying capacity for a fuller buildout.
Typical setup
Keep storage light and avoid buying major processing equipment at launch.
Use mixed equipment access and keep the first buildout close to the model's core assumptions.
Fund the farm as a scaled operation with more in-house handling and less reliance on outside services.
Cost drivers
Land leases
custom equipment
basic storage
labor
Land purchase
lease cash
mixed equipment
compliance
processing
Owned land
tractors and harvester
irrigation
storage and drying
labor
Planning rangeCAPEX only
Lease-first funding bandLow cash need
$150,000 land capex + $72,000 lease cashCore model base
Mechanized growth funding bandHighest cash load
Best fit
Best for founders testing hemp with flexible acreage and tight cash control.
Best for operators who want the model's core economics and a lender-ready plan.
Best for teams funding a broader buildout and aiming for faster scale.
!
Planning note: Scenario ranges are researched planning assumptions, not exact vendor quotes.
The researched base case starts with 50 hectares in the first operating year It assumes 20% owned land, or 10 hectares, and 80% leased land, or 40 hectares That land mix creates $150,000 of land purchase CAPEX and $72,000 of first-year lease cash before equipment, compliance, and crop operating costs
Revenue timing depends on crop and buyer terms, but harvest is not modeled in the opening months Fiber, hurd, and biomass harvests are modeled in month 8, while grain is modeled in month 9 Sales cycles run 4 to 8 months by crop line, so working capital has to cover the gap
Yes, industrial hemp farming requires licensing through a state hemp program or the United States Department of Agriculture program where applicable Costs vary by state, so don’t use one national fee Budget for the license, recordkeeping, THC sampling and testing, and possible background checks, plus insurance and professional support
The best path is to match equipment ownership to acreage and cash For a 50 hectare launch, buying all machinery may strain early cash, while leasing, sharing, or custom hiring can shift cost from CAPEX into operating expense Include tractors, seed drills, sprayers, irrigation, trailers, and harvest support in the comparison
Farm-level drying, storage, baling, material handling, and transport readiness should be included Full downstream processing is separate This startup budget should not include decortication plants, textile manufacturing, construction material production, or bioplastics manufacturing Keep those out of the farm launch budget unless the business plan adds a separate processing facility
About the author
Paul Wells
Practical Finance Writer
Paul Wells is a practical finance writer for Financial Models Lab who focuses on cost-to-open estimates and monthly expense breakdowns that help founders avoid common launch mistakes. He simplifies business plans for non-finance readers and brings a grounded, founder-minded perspective to startup cost research.
