Outpatient Clinic Startup Costs: $815K CAPEX Plus Cash Reserve
Outpatient Clinic
Key Takeaways
Build-out costs hinge on space type and specialty scope.
Diagnostic and procedure equipment drive most clinical CAPEX.
EHR setup needs upfront spend plus monthly licenses.
Licensing, payroll, and insurance start before first patient.
Estimate Startup Costs with Calculator

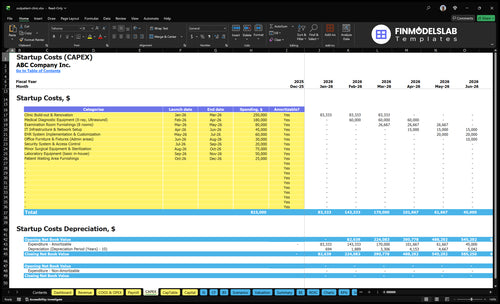

Startup CAPEX Calculator
This estimates capitalized startup assets only for an outpatient clinic, including buildout, equipment, IT/EHR, furnishings, and contingency.
!
CAPEX only This calculator covers capitalized startup assets only. It excludes inventory, payroll runway, rent deposits, debt service, working capital, marketing, patient acquisition spend, credentialing delays, and other operating expenses.
Does the Outpatient Clinic model show CAPEX and cash runway?
What drives outpatient clinic buildout costs the most?
Facility condition, room count, and core systems drive most outpatient clinic buildout costs. Use $250,000 as a base for clinic build-out and renovation in Months 1 to 3, then add costs for plumbing, electrical, HVAC, accessibility, waiting flow, and clinical workflow; landlord allowance can reduce what you fund up front. If you add diagnostics or procedure space, CAPEX jumps fast: plan $180,000 for diagnostic equipment, $75,000 for surgical and sterilization equipment, and $50,000 for lab equipment.
Biggest cost drivers
Facility condition sets the base.
More exam rooms raise fit-out cost.
Plumbing and electrical are major CAPEX.
HVAC and accessibility add needed spend.
Added room costs
$180,000 diagnostic equipment.
$75,000 surgical and sterilization gear.
$50,000 lab equipment.
Landlord allowance can offset cash need.
How much money do I need to open an outpatient clinic?
You need about $1,023,000 to open an Outpatient Clinic before lender buffers and debt service: $815,000 in capital spending (CAPEX) plus a $208,000 minimum cash reserve. This is not just the medical clinic buildout cost, and it connects directly to What Is The Primary Goal Of Outpatient Clinic? because the budget must cover launch capacity, payroll, fixed overhead, and early cash risk.
Startup Budget
$815,000 CAPEX
$208,000 minimum cash reserve
$1,023,000 total before lender buffers
Excludes separate debt service needs
Operating Assumptions
$25,300 monthly fixed expenses
$325,000 Year 1 admin payroll
65% first-year capacity assumption
Month 2 break-even timing
Provider compensation is not separately given in the supplied data, so don’t add a salary layer unless your model adds that line item explicitly.
How should I build an outpatient clinic funding plan?
Build the Outpatient Clinic funding plan around the $815,000 CAPEX schedule from Month 1 to Month 12, plus startup costs, staffing ramp, and payer lag so you still hold $208,000 minimum cash by Month 12. The base plan shows $66,000 first-year EBITDA, Month 2 break-even, 28-month payback, 6% IRR, and 816% ROE, so lenders will want the revenue, capacity, payroll, fixed cost, and contingency assumptions tied to each month. Here’s the quick math: cash needs are front-loaded, but reimbursement timing can still squeeze runway, so model the gap before the clinic scales.
Funding plan basics
Spread CAPEX across 12 months
Cover startup and ramp costs
Protect $208,000 cash by Month 12
Match cash to reimbursement lag
Lender-ready model
Show visit volume by month
Cap capacity with staffing
Include payroll and fixed costs
Add a contingency cushion
Calculate Fuding Needs
Startup cost summary
This table summarizes startup assets and the separate cash reserve needed to open and run the outpatient clinic.
Highlighted CAPEX$815,000Base planning example
Excluded cash needs$208,000Outside CAPEX total
Funding need$1,023,000CAPEX + excluded cash needs
Cost Category
Base Estimate
Main Cost Driver
CAPEX Calculator
Clinic Build-out & Renovation
$250,000
Square footage and finish level of the clinic build-out
Yes
Medical Diagnostic Equipment
$180,000
Diagnostic modality scope and installation requirements
Yes
Minor Surgical & Lab Equipment
$125,000
Sterilization gear and in-house lab setup
Yes
IT, EHR & Security Setup
$125,000
IT build, EHR customization, and access control scope
Yes
Furnishings, Fixtures & Waiting Area
$135,000
Exam room count, admin furniture, and waiting area fit-out
Yes
Minimum Cash Reserve
$208,000
Month 12 cash need tied to ramp and collection timing
No
Outpatient Clinic Core Five Startup Costs
Clinic build-out and leasehold improvements Startup Expense
Build-Out CAPEX
Treat this as CAPEX: about $250,000 over Months 1-3 to turn leased space into a compliant outpatient clinic. It should cover exam rooms, reception, waiting, staff work areas, patient flow, electrical, plumbing, HVAC, accessibility, safety, storage, and clinical workflow. Cost depends heavily on whether the site is second-generation medical space or raw office space.
Cost Drivers
Here’s the quick math: the build-out is not just finishes; it is the work needed to make patients move safely and staff work efficiently. Ask for quotes that break out demolition, framing, electrical, plumbing, HVAC, accessibility, and code items. Specialty services, diagnostics, and minor procedures can push the total up fast.
Reduce Waste
Start with space that already looks like a clinic, not a blank office. That cuts hidden costs in walls, utilities, and patient flow changes. Lock the room count and service mix before work starts, because adding procedures later is expensive. One clean rule: don’t design for services you won’t open on day one.
Use second-generation medical space first.
Freeze scope before permits.
Separate base clinic from add-ons.
Scope Check
Before you budget, confirm three inputs: space condition, room count, and service mix. A raw office needs far more work than a fitted medical suite, and adding imaging or minor procedures changes electrical, plumbing, HVAC, and safety requirements. That’s the main reason the same square footage can land at very different costs.
Medical equipment and exam room setup Startup Expense
Equipment split
Durable clinical gear is the startup spend here, while disposables stay in operating costs. The core CAPEX is $180,000 for X-ray and ultrasound, $80,000 for 8 exam rooms, $75,000 for minor surgery and sterilization, $50,000 for lab equipment, and $25,000 for waiting furnishings.
Exam rooms
Exam room setup starts at about $10,000 per room ($80,000 divided by 8). That budget should cover exam tables, chairs, carts, storage, and basic room furnishings, plus the waiting area at $25,000. The estimate moves most when room count and furnished scope change.
Service lines
Service-line CAPEX should be tracked separately: $180,000 for imaging, $75,000 for minor procedures and sterilization, and $50,000 for in-house lab gear. That split shows which revenue lines need the biggest upfront cash and which rooms need sterilization, storage, and procedure-ready layouts before you open.
Purchase control
Keep the buy list tight by matching it to day-one services and getting separate quotes for imaging, exam furniture, minor-procedure tools, and lab equipment. Keep disposable supplies off the CAPEX list. That avoids paying for items you’ll replace before they earn back cash.
EHR, practice management, and IT setup Startup Expense
EHR Core
An EHR (electronic health record) is the system for charting, orders, patient records, and clinical documentation. For an outpatient clinic, plan on $60,000 for implementation and customization, plus $45,000 for IT infrastructure and network setup. It’s the backbone for scheduling and care coordination.
Cost Build
Here’s the quick math: $1,200 a month is $14,400 over 12 months, so the startup total is about $119,400 before add-ons. Use vendor quotes for each module and check that the package covers scheduling, billing, claims, patient portal, telehealth, cybersecurity, computers, network hardware, reporting, and implementation support.
Trim It Right
Keep it lean by buying only the modules you need at launch, getting fixed quotes, and separating one-time setup from recurring licenses. Don’t underfund training or cybersecurity; rework and downtime usually cost more than a clean setup. The best savings come from avoiding features nobody will use.
Claims Lag
Software can speed charge capture and claim edits, but it does not control payer approval or payment timing. Build your cash plan around collections, not just submission dates, so a better billing workflow doesn’t create a false sense of liquidity.
Licensing, credentialing, compliance, and insurance Startup Expense
Go-live setup
Before the first patient, the clinic needs state registration, provider enrollment, payer credentialing, legal setup, policies and procedures, coding setup, and revenue cycle controls. Build this into the startup budget, because you cannot bill payers until the admin side is live. This also includes $3,000 a month for professional liability insurance and $600 for waste and biohazard disposal.
Cost drivers
Requirements vary by state, but the main inputs are the service list, ownership structure, diagnostics, minor procedures, and payer mix. Estimate this line by pricing the required filings, credentialing work, policies, and insurance for the exact clinic scope, not a generic outpatient model.
State rules change the filing load.
Procedures add more controls.
Payer mix changes enrollment work.
Keep it lean
Start with the minimum scope needed to open and bill. Don’t add extra services or broad coverage before the paperwork is done, because each step can trigger more forms, more review, and more cost. Get quotes early, and update them if launch slips.
Match coverage to services.
Price quotes before launch.
Delay extras until ready.
Monthly burn
At the stated monthly rates, compliance-related operating cost is $3,600, or $43,200 a year, before any state filing fees or legal work. That makes this line item an ongoing cash need, not a one-time launch fee, so it should sit next to payroll and rent in the opening budget.
Pre-opening payroll, training, supplies, and launch operations Startup Expense
Pre-open payroll
Pre-opening staffing is a launch cost, while long-term payroll belongs in monthly operations. Use $325,000 for Year 1 admin payroll, or about $27,083 per month, covering the clinic director, lead receptionist, administrative assistant, billing specialist, marketing and patient relations, and IT support.
Launch team
Plan clinical launch staffing separately: 2 primary care physicians, 1 diagnostic technician, 1 specialist physician, 1 minor procedure nurse, and 2 medical assistants. This cost is driven by headcount, onboarding length, and whether staff are paid before first patient revenue. Include training, uniforms, initial supplies, and billing setup in the opening budget.
Set training before first appointments.
Buy uniforms before patient intake.
Ready billing before claims start.
Billing readiness
Keep launch cash tight by tying spend to go-live dates, not vague staffing plans. The biggest mistake is mixing opening payroll with steady-state payroll, which hides runway needs. Here, the real budget questions are how many weeks of training you need, when billing can submit clean claims, and how much pre-opening supply and marketing spend you need.
Match spend to opening date.
Track training weeks, not guesses.
Test claims before day one.
Opening cash needs
For this clinic, launch cash should cover the $325,000 admin payroll plan, clinical onboarding for 6 launch staff roles, plus training, uniforms, supplies, launch marketing, and billing readiness before collections begin. If any of those items slip past opening, cash burn rises fast, so line each one up to a month and owner.
Compare 3 Startup Cost Scenarios
Launch cost scenarios
Startup cost changes mostly with exam room count, diagnostics, lab scope, and staffing. Lean trims procedures, Base matches the model anchor, and Full adds specialty services and imaging.
Lean, Base, and Full clinic launch cost comparison
Scenario
Lean LaunchCapital light
Base LaunchModel anchor
Full LaunchExpansion play
Launch model
Starts with a smaller clinic footprint, fewer diagnostics, and limited minor procedures.
Uses the model anchor: 8 exam rooms, core diagnostics, EHR, minor procedures, and standard staffing.
Adds specialty services, broader imaging, more in-house lab work, and heavier staff coverage.
Typical setup
Uses fewer exam rooms, lighter imaging, and lean staffing to keep the build simple.
Centers on the $250,000 build-out, $180,000 diagnostics, $60,000 EHR, and a basic in-house lab.
Extends the buildout, equipment, and room count to support higher visit volume and wider service lines.
Cost drivers
Smaller buildout
fewer exam rooms
reduced diagnostics
limited minor procedures
lean staffing
8 exam rooms
$250,000 build-out
$180,000 diagnostics
$60,000 EHR
standard staffing
Expanded specialties
larger lab
more imaging
heavier staffing
more complex buildout
Planning rangeCAPEX only
$550,000 - $700,000Lowest funding need
$815,000 - $1,025,000Balanced launch
$1,050,000 - $1,450,000Highest funding need
Best fit
Fits founders testing demand in one location with tight capital and a narrow service mix.
Fits operators funding a full-service outpatient start with a clear path to scale.
Fits well-funded teams aiming for a larger, more complex clinic from day one.
!
Planning note: Scenario ranges are researched planning assumptions, not vendor quotes or exact bids.
This model points to a $208,000 minimum cash reserve in Month 12, on top of $815,000 in CAPEX That puts the planning need near $102 million before debt service or lender-required cushions The reserve matters because the first operating year carries $25,300 in monthly fixed costs plus about $27,083 in monthly admin payroll
The researched model shows break-even in Month 2, with a 28-month payback period That result depends on hitting 65% capacity in the first operating year and controlling fixed expenses at $25,300 per month If payer enrollment, staffing, or patient volume slips, the cash reserve becomes more important than the headline break-even date
It depends on the state, services offered, payer mix, and whether the clinic provides diagnostics, lab work, or minor procedures This setup includes $180,000 of X-ray and ultrasound equipment, $50,000 of basic lab equipment, and $75,000 of minor surgical and sterilization equipment Those services can raise compliance, policy, inspection, and insurance requirements
At minimum, plan for professional liability and general business coverage, with requirements tied to services and ownership structure The model includes $3,000 per month for professional liability insurance It also includes $600 per month for waste management and biohazard disposal, which matters when the clinic handles lab work, procedures, or regulated medical waste
Start by reducing CAPEX without weakening care quality or compliance The biggest levers are the $250,000 build-out, $180,000 diagnostic package, $75,000 minor surgical setup, and $50,000 lab equipment A lean launch can delay in-house diagnostics or procedures, but it must still fund the $60,000 EHR implementation and enough cash runway
