How To Start A Drone Delivery Service: 3–6 Month Pilot Plan
Key Takeaways
- FAA approval sets the legal go-live gate.
- Route design shapes safety, coverage, and unit economics.
- Test flights prove aircraft and payload readiness.
- Paid pilots and insurance reduce launch and shutdown risk.
Launch timeline
This short web summary shows the launch path; the XLSX export holds the detailed Gantt chart.
- Permit review
- Insurance bind
- Cert filing
- Flight rules
- Zone mapping
- Landing checks
- Route draft
- Corridor test
- Vendor quotes
- Drone order
- Hub install
- Parts buy
- System scope
- Platform build
- Route testing
- Go-live fixes
- Role plan
- Hire core team
- SOP training
- Drill response
- Target accounts
- Pilot offers
- Launch gate
- First deliveries
Does your launch model prove the route?

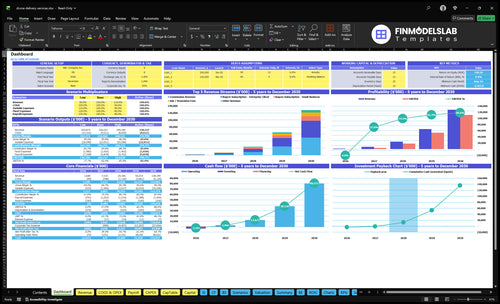

This screenshot shows revenue, costs, cash needs, assumptions, and break-even logic—open the Drone Delivery Service Financial Model Template.
Financial model highlights
- 200 sellers, 5,000 buyers
- 70/20/10 buyer mix
- 50/30/20 seller mix
- Fleet, staffing, route capacity
- Contract scenarios and runway
- Year 1-5 revenue ramp
- 40% energy, gateway fees
What are the biggest drone delivery launch risks?
The biggest launch risks for Drone Delivery Service are the FAA path, unrealistic routes, weak safety SOPs, an under-tested fleet, and poor landing-zone coordination. A paid launch should wait until you have a repeatable route, approved aircraft, trained pilots, documented emergency response, and a signed pilot customer. If the landing zone or customer handoff is not ready, pause and run a route-by-route go-live checklist.
Top launch blockers
- Unclear FAA path
- Unrealistic route design
- Weak safety SOPs
- Under-tested fleet
Go-live readiness
- Repeatable route
- Approved aircraft
- Trained pilots
- Signed pilot customer
How do you get customers for a drone delivery service?
For Drone Delivery Service, start with B2B pilot partners—hospitals, labs, pharmacies, campuses, retailers, local logistics companies, and controlled-route operators—not broad consumer demand; if you need the launch-cost side, see How Much Does It Cost To Open And Launch Your Drone Delivery Service Business?. The first revenue step should be a paid pilot with one defined route, payload type, delivery window, safety workflow, and reporting package. In year 1, the model assumes $100,000 in seller marketing at $500 CAC, or 200 sellers, with a mix of 50% local retail, 30% food service, and 20% medical supply.
Sell pilots first
- Target B2B pilot partners first
- Sell one route, not broad demand
- Charge for the first pilot
- Use hospitals, labs, pharmacies, campuses
Use the year-1 mix
- $100,000 seller marketing budget
- $500 CAC implies 200 sellers
- 50% local retail, 30% food service
- 20% medical supply, then expand
What permits do you need for a drone delivery business?
A Drone Delivery Service needs Federal Aviation Administration (FAA) approval first: Part 107 for small unmanned aircraft systems under 55 lb, Remote ID, aircraft registration, airspace authorization, and waivers for operations like beyond visual line of sight (BVLOS). If you’re measuring readiness, tie permits to route economics in What Is The Most Important Metric To Measure The Success Of Your Drone Delivery Service?, because one blocked route can break the delivery model. This isn’t legal advice; use aviation counsel and engage the FAA before selling paid routes.
FAA permits
- Part 107 remote pilot rules
- Remote ID for registered drones
- Airspace authorization for controlled zones
- Waivers for BVLOS or night limits
Business approvals
- Part 135 may apply to paid delivery
- Register aircraft used commercially
- Secure insurance and landing-zone permissions
- Check route, payload, autonomy, and altitude
Confirm if the drone delivery launch is ready or blocked
Launch readiness checklist
Use this go-live approval checklist to confirm the drone delivery service is ready before opening.
- FAA operating path approvedCritical
No flight should start until the operating path is clear and documented.
- Remote ID configuredCritical
Remote ID must work before any live customer delivery.
- Insurance bound for flightsCritical
Flight insurance should be bound before launch month.
- Regulatory retainer activeHigh
A live counsel retainer helps unblock legal issues fast.
- Route permissions clearedCritical
Routes need approved access before you promise service areas.
- Landing zones confirmedCritical
Landing zones cut missed drops and safety delays.
- Ground support sites readyHigh
Ground sites need power, storage, and secure access.
- Drone fleet commissionedCritical
Fleet acceptance proves drones can fly the first paid jobs.
- Battery swap SOP approvedHigh
Battery swaps need a standard process from day one.
- Maintenance logs readyHigh
Maintenance logs keep faults visible before they spread.
- Battery inventory stockedMedium
Spare batteries prevent downtime during early demand spikes.
- Dispatch software testedCritical
Dispatch software must book, route, and track orders cleanly.
- Customer notifications readyHigh
Customers need status alerts before the first delivery.
- Proof of delivery liveHigh
Proof of delivery closes disputes and supports billing.
- Customer contracts signedCritical
Signed terms make repeat orders easier to control.
- Pilot staffing coveredCritical
Each flight needs a named pilot and backup coverage.
- Flight controller schedule setHigh
Coverage must match launch hours and surge demand.
- Training and drills completeCritical
Drills should cover crashes , weather, and lost links.
- Emergency response runbook approvedCritical
Clear escalation steps keep small events from becoming shutdowns.
- Cash covers Month 8 troughCritical
The Month 8 cash trough is the main launch risk.
- Year 1 budgets checkedHigh
Seller spend is $100k at $500 CAC; buyer spend is $250k at $50 CAC.
- CAC targets must holdHigh
If CAC slips, the model breaks before scale helps.
- Breakeven path approvedCritical
Month 7 breakeven looks good, but payback is 26 months.
- Final signoff blockedCritical
Open only when legal, route, aircraft, people, customer, and safety gates are green.
Which launch drivers decide go-live?
FAA approval is the launch gate, so route promises wait until legal flight authority is clear.
Mapped routes with range and weather limits cut failed deliveries and tighten the pilot scope.
Real-route test flights prove the drone can carry the planned package on day one.
Documented SOPs keep flights, handoffs, and incident response repeatable without founder heroics.
Signed pilot customers and Year 1 demand targets show whether supply has real pull.
Bound coverage and community controls lower shutdown risk and help keep first flights live.
Regulatory Approval Path
FAA Approval Path
The business cannot open on time until the flight authority is real. The permitted flight profile controls routes, payloads, autonomy, staffing, insurance, and the first legal launch date, so this is a hard go/no-go gate for day-one delivery.
Readiness means the right path is in hand: Part 107, Remote ID compliance, airspace authorization, a waiver, or a Part 135-related path as needed. If the plan needs BVLOS (beyond visual line of sight), that must be confirmed early, because promising routes before authority exists creates launch delays and sales risk.
Sequence Approvals Before Sales
Start with the operating model, then document the flight profile, then confirm whether BVLOS is required. That order matters because the route, package size, and autonomy level drive the approval path, not the other way around. One clear sentence helps here: no authority, no route promise.
- Define aircraft use and delivery profile
- Check Remote ID and airspace needs
- Map waiver or Part 135 path
- Lock routes before selling service levels
- Assign approval owner and filing dates
Remote ID has been required in the U.S. since September 16, 2023, so a launch plan that skips it is not realistic. What this estimate hides is the time lost when sales, ops, and compliance work in parallel without a filed approval path; that usually pushes the opening date and leaves staff ready before the business can legally fly.
Service Area And Route Design
Service Area And Route Design
Route design is what turns a drone idea into a service you can open. A mapped service area with airspace review, battery margin, payload fit, and weather limits decides whether the business can fly safely and repeatably on day one. If the first routes are not tight enough for the promised sub-30-minute delivery, launch slips or customers get late drops.
This driver also sets the first operating scope. You need landing zones, customer handoff, and a backup process for bad weather or site problems. Without customer site permission and a route that fits the aircraft range and the FAA path, the team can be ready to sell before it can legally or practically deliver.
Map the first corridor
Start with one narrow route, not a broad launch area. Verify the FAA path, the aircraft range, and each site permission before you promise volume. Then lock the route sheet with the package limit, weather cutoff, landing spot, and handoff step so pilots, support, and sellers use the same plan.
- Check airspace before sales
- Match payload to package size
- Set weather stop rules
- Test a backup landing plan
A weak route plan creates failed deliveries, extra pilot time, and more customer support on day one, which burns cash and slows first revenue. One clean route with a clear backup is better than three messy ones that only work in perfect weather.
Aircraft And Payload Readiness
Aircraft and Payload Readiness
Aircraft choice, payload capacity, and range set what the service can promise on day one. If the drone can’t carry the real package, cover the real route, and turn fast enough between flights, opening slips from a launch plan into a limited pilot. The key dependency is route design, because range and payload limits decide which zones are even serviceable.
The readiness signal is repeated test flights on the actual route with the actual package type. That also means charging setup, maintenance records, redundancy, and spare parts are in place before sales start. Buying aircraft before route needs are clear is a common bottleneck, because it can leave you with fleet capacity that looks good on paper but fails in practice.
Verify the Fleet Before Selling Slots
Lock the aircraft spec to the route, not the other way around. Confirm payload limit, battery turnaround, and maintenance status, then test the full loop with the exact package customers will send. If the drone passes the route but fails the load, it is not launch-ready.
Build a simple readiness file with the items below so day-one capacity is real, not assumed:
- Aircraft model and payload rating
- Route distance and battery margin
- Charging plan and spare batteries
- Maintenance log and spare parts
- Backup drone for downtime
- Test-flight results on live route
Operations And Safety Systems
Built-to-Run Safety Operations
Operations and safety systems are what turn drone delivery from a pitch into a service that can open on time. If dispatch workflow, pilot roles, flight logs, maintenance records, battery handling, emergency response, customer notifications, incident reporting, and proof of delivery are not documented, every paid flight depends on founder memory and slows the launch.
For a sub-30-minute delivery promise, the team has to run the handoff cleanly on day one. The readiness signal is a documented SOP that covers software, training, insurance, and the customer handoff, so first deliveries are safer, easier to audit, and less likely to slip.
Build the launch playbook first
Start with one route, one aircraft setup, and one customer handoff. Test the dispatch flow, pilot checklist, battery swap, and incident report before taking payment, then fix every step that still needs founder intervention. If staff cannot run it twice the same way, it is not ready.
Keep these items in the launch file:
- Dispatch and pilot assignment rules
- Flight logs and maintenance records
- Battery handling and charging steps
- Emergency response and escalation contacts
- Customer notification and proof of delivery
Anchor Customer Development
Anchor Pilot First
Open only after one customer has committed to a signed paid pilot. In drone delivery, the first real launch risk is not the aircraft; it’s launching supply before you have defined routes, known package types, predictable volume, and feedback from the site operator.
The best launch signal is a paid pilot with a medical, campus, lab, retail, or local logistics partner. That gives you route proof, faster first revenue, and cleaner proof points. Skip broad demand spend before route proof; seller acquisition is assumed at $500 CAC versus $50 CAC for buyers, so wasted seller outreach burns cash fast.
Lock Pilot Scope Early
Before opening, verify the route map, package list, handoff method, weekly volume, and who gives pilot feedback. If any of those are vague, day-one service will slip because ops, staffing, and customer promises won’t match real flight limits.
- Confirm one paid pilot contract.
- Document route, payload, and volume.
- Test feedback before launch.
- Delay mass ads until route proof.
One clean route beats ten shaky leads. If the pilot partner can’t commit volume, the launch bottleneck is demand, not delivery.
Insurance And Community Risk Management
Insurance And Community Risk
Drone delivery cannot open cleanly if insurance and public risk are still loose. Bound coverage, privacy rules, safety docs, and incident response need to be set before the first paid flight, because they affect approval, customer trust, and whether you can keep flying after a complaint or minor event.
This driver depends on aircraft type, route, payload, and flight authority. Noise, privacy, safety, and property access are the usual friction points, so weak community prep can turn a launch delay into a shutdown risk after go-live.
Lock the risk file before sales
Verify insurance is bound, then document privacy practices, landing-zone controls, and the incident response playbook. Treat the standard operating procedure (SOP) as launch-critical: who handles complaints, who logs events, who pauses flights, and who talks to neighbors and local stakeholders.
Before opening, test one route with the actual payload, then confirm the noise plan and customer handoff. If public acceptance is an afterthought, the business may have the permit path but still lose operating time to avoidable objections, access issues, or flight stoppages.
- Bind coverage before first flight.
- Document privacy and noise controls.
- Assign complaint and incident owners.
- Secure landing-zone access in writing.
- Message neighbors before launch day.
Related Products
- Drone Delivery Service Porter's Five Forces Analysis
- Drone Delivery Service BCG Matrix
- Drone Delivery Service Business Model Canvas
- 7 Essential KPIs for Drone Delivery Service Profitability
- Drone Delivery Service Business Plan Template in Pre-Written Word
- 7 Financial Strategies to Increase Drone Delivery Service Profitability
- How Much Does It Cost To Operate A Drone Delivery Service?
- Drone Delivery Startup Costs: $1235M First-Year Operating Floor
- Drone Delivery Financial Model Template in Excel
- Drone Delivery Service Owner Income: $645-$696 Per Order
- How to Write a Drone Delivery Service Business Plan
- Drone Delivery Service Marketing Mix
- Drone Delivery Service Marketing Plan
- Drone Delivery Service Business Proposal
- Drone Delivery Service PESTEL Analysis
- Drone Delivery Service Pitch Deck Example Editable PPTX
- Drone Delivery Service Business SWOT Analysis
- Drone Delivery Service Value Proposition Canvas
Frequently Asked Questions
Start with one controlled route and one paying partner Confirm the FAA path, aircraft fit, insurance, landing zones, pilots, dispatch workflow, and emergency procedures before selling public delivery Use the model to test demand: Year 1 assumes $100,000 seller marketing at $500 CAC and $250,000 buyer marketing at $50 CAC
