How To Open A Hydroponic Farm In 3 To 9 Months With First Buyers
You’re setting up a controlled growing business, so the launch plan has to cover the crop mix, compliant space, water systems, utility readiness, buyer outreach, and first harvest This guide uses a 10-period planning model with Year 1 assumptions of 1 hectare, 0% owned land, $7,000 monthly lease cost per hectare, and a leafy-greens-and-herbs mix Your practical next step is to validate the facility, harvest schedule, and buyer pipeline before committing to full buildout
Launch timeline
This short web summary shows the launch plan, and the XLSX export contains the detailed Gantt Chart.
- Select farm site
- Negotiate lease
- File permits
- Review compliance
- Finalize layout
- Install racks
- Fit HVAC
- Run water tests
- Commission dosing
- Set crop mix
- Build sowing calendar
- Source seed stock
- Set nutrient mix
- Start trial grow
- Request quotes
- Choose suppliers
- Order nutrients
- Order packaging
- Arrange fleet
- Hire manager
- Hire operators
- Train safety
- Train harvest team
- Run dry drills
- Build buyer list
- Start outreach
- Send samples
- Lock purchase terms
- First harvest sale
Does Hydroponic Farming’s model support the launch plan?

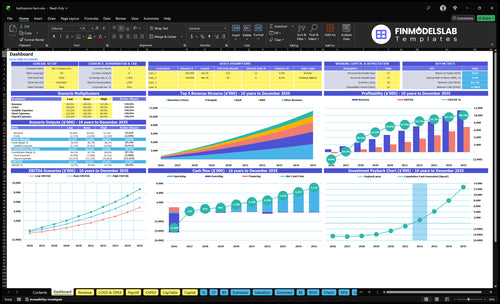

Yes—the dashboard and assumptions tabs test launch timing, crop mix, yield, harvest months, lease, staffing, runway, and break-even; Year 1 crop revenue is about $129,960 versus an $84,000 lease. Open the Hydroponic Farming Financial Model Template.
Launch model highlights
- 30/25/20/15/10 crop mix
- Five percent yield loss
- Six harvest months
How long does it take to open a hydroponic farm?
Opening a Hydroponic Farming site usually takes 3 to 9 months. The pace depends on site selection, zoning, utility upgrades, system install, water testing, crop trials, food safety setup, and buyer readiness. If power, HVAC, drainage, or water quality are not ready, first revenue can slide to a later harvest cycle.
Opening window
- 3 to 9 months is the practical range.
- Site fit and zoning set the pace.
- Utilities can speed or slow launch.
- Install waits on layout and access.
Main delay points
- Power, HVAC, drainage, and water quality matter most.
- Reservoirs, pumps, racks, and lights must fit cleanly.
- Crop trials must prove yield and quality.
- Year 1 assumes 6 harvest months and 5% yield loss.
What do you need to start a hydroponic farm?
To start Hydroponic Farming, you need a grow space, hydroponic system, clean water, nutrients, lighting or greenhouse controls, HVAC, crop plan, food safety process, packaging, and buyers; see What Is The Current Growth Rate Of Hydroponic Farming? for market context. In the Year 1 model, plan around 1 hectare, 0% owned land, and $7,000/month lease cost per hectare, while prioritizing must-haves before sensors, automation, or extra software.
Start-up must-haves
- Test water before planting
- Buy pumps, reservoirs, and channels
- Secure nutrients, seeds, or seedlings
- Set lighting, drainage, and humidity control
Revenue readiness
- Grow romaine lettuce, arugula, basil, mint, kale
- Use packaging that protects freshness
- Sample buyers before full production
- Track quality, volume, and delivery reliability
How do you get customers for a hydroponic farm?
Build the buyer pipeline before the first harvest: sell romaine lettuce, arugula, basil, mint, and kale to restaurants, grocers, farmers markets, CSA customers, meal-prep companies, and local distributors, with clear pack sizes, delivery days, and shelf-life expectations. Year 1 prices can start at $15 for romaine lettuce, $18 for arugula, $22 for basil, $20 for mint, and $16 for kale; if you’re mapping startup spend too, see How Much Does It Cost To Open A Hydroponic Farming Business? The first sale should prove consistent quality, clean packaging, and reliable delivery, not just a social post.
Sell first, harvest second
- Target restaurants and grocers first.
- Pitch farmers markets and CSA buyers.
- Offer meal-prep and distributor samples.
- Set prices before the first cut.
Make buyers repeat
- Sample romaine, arugula, basil, mint, kale.
- State pack sizes and delivery days.
- Show shelf-life expectations up front.
- Prove harvest volume can repeat.
Define what must be ready before opening and selling hydroponic produce
Launch readiness checklist
Use this go-live checklist to confirm the farm is ready before opening month and first sales.
- Registration filedCritical
You need a legal entity before permits, bank accounts, and contracts.
- Zoning and lease rights clearedCritical
The site must allow farm use before fit-out spending starts.
- Sales tax handling confirmedHigh
You need the right tax treatment before invoicing buyers.
- Produce handling rules reviewedHigh
Fresh produce rules affect cleaning, storage, and delivery steps.
- Buyer documents mappedMedium
Restaurants, grocers, and distributors may ask for different docs.
- Cultivated area set to 1 hectareCritical
Year 1 is modeled on 1 hectare, so space must match the plan.
- Power and water capacity provenCritical
LEDs, pumps, and climate control need stable power and water.
- Drainage and HVAC testedHigh
Poor drainage or HVAC control can wipe out yield fast.
- Humidity and lighting stableHigh
Leafy greens and herbs need steady conditions to stay consistent.
- Racks, pumps, reservoirs installedCritical
Core grow hardware must work before any crop goes into the system.
- Nutrients and seedlings on handCritical
No inputs means no crop, and startup delays hit cash hard.
- Crop trial completed in-houseHigh
A trial catches weak yields, water issues, and handling mistakes early.
- Backup input suppliers namedHigh
Seeds and nutrients need a backup when the first vendor slips.
- Backup packaging supplier namedHigh
Packaging shortages can stop packing and shipping even when crops are ready.
- Backup repair and delivery vendors namedMedium
Fast repairs and delivery help keep harvested product moving.
- Seeding and transplanting trainedHigh
Early plant loss usually starts with weak seeding or transplant work.
- Harvest and sanitation trainedHigh
Clean harvesting protects shelf life and reduces food safety risk.
- Packaging, delivery, records trainedHigh
Good records help trace lots, shipments, and losses.
- Buyer commitments securedCritical
You need real demand before the first harvests hit the dock.
- Six harvest months plannedHigh
The model assumes six harvest months, so timing must be clear.
- Year 1 cash plan testedCritical
Minimum cash turns negative in Month 12, so runway must cover the dip.
- 79-month payback acceptedMedium
The model payback is 79 months, so investors need that horizon.
- Year 1 EBITDA loss fundedCritical
Year 1 EBITDA is negative $308k, so opening needs loss coverage.
Want the six hydroponic farming success factors before launch?
A 3-9 month launch window means site, utilities, and drainage must be ready before idle lease burns cash on 1 hectare.
System design must fit leafy greens and herbs so pumps, sensors, and lighting support clean, reliable crop cycles.
A five-crop mix, six harvest months, and 5% Year 1 yield loss set harvest volume and buyer fit from day one.
Records for water, cleaning, labels, and lot tracking help avoid buyer pushback when first produce ships.
Pre-selling restaurants, grocers, and local distributors turns the first harvest into revenue instead of waste.
Train staff before commercial harvest so seeding, checks, packaging, and deliveries run the same way every day.
Facility And Utility Readiness
Facility and utility readiness
Facility readiness decides whether the farm opens on time and protects crops on day one. Check zoning fit, lease rights, layout, and utility capacity before signing off. The Year 1 model assumes 1 hectare at $7,000 per month, so idle space burns $84,000 a year before sales start.
For indoor hydroponics, test power, water access, drainage, HVAC, and humidity control before system install. Late utility work is a launch bottleneck because weak cooling, poor drainage, or unstable humidity can raise crop loss and delay the first harvest.
Test utilities before install
Use a pre-open walk-through to verify the hard stuff first: receiving flow, delivery flow, sanitation zones, pest controls, and clean paths for staff and product. If the layout forces cross-traffic, you slow harvest handling and raise contamination risk.
Ask for proof, not promises. Confirm utility sign-off, run water and drain tests, and document what is ready before equipment lands. That keeps install crews moving and avoids paying lease cost on a space that still can’t grow crops.
What to verify before opening:
- Zoning and permitted use
- Lease rights and occupancy timing
- Power capacity and backup needs
- Water supply and drainage path
- HVAC and humidity setpoints
- Sanitation and pest-control zones
- Receiving and delivery traffic flow
One clean site check can save a missed launch.
Hydroponic System Design And Installation
System Setup Must Fit The Crop Plan
Opening day depends on whether the hydroponic system matches the actual crop mix and harvest rhythm. For leafy greens and herbs, that means the right mix of pumps, reservoirs, grow channels, raft beds or vertical racks, sensors, nutrient dosing, lighting, backup power, and maintenance access. If the layout is hard to clean or has one failure point, you risk missed harvests and slow fixes in the first month.
Installation should wait until utility readiness, water testing, drainage, and layout approval are complete. That sequence matters because indoor hydroponic farms use controlled water and power from day one, not as a later upgrade. If setup slips on a 1 hectare site, the model still carries about $7,000 per month in lease cost before sales, so a late install burns cash and delays first revenue.
Verify Utilities Before The Equipment Arrives
Start with the build list, not the gadget list. Confirm the system is sized for leafy greens and herbs, then lock the install order: power, water, drainage, layout approval, then racks, tanks, channels, sensors, and dosing gear. Keep access wide enough for cleaning and repairs, because tight layouts slow troubleshooting and can stop a whole crop row.
Hydroponics can use up to 90% less water than conventional farming, but that only helps if the system is tuned and running clean. Before opening, test backup power, check water quality, and document every connection and valve. If the crew cannot reach a pump or sensor fast, issue diagnosis gets slower, records get messy, and the first crop cycle becomes the repair cycle.
- Match system size to crop mix.
- Test utilities before final install.
- Leave clear access for cleaning.
- Avoid single points of failure.
- Document sensors, pumps, and dosing.
Crop Planning And Yield Assumptions
Crop Mix And Yield Plan
Crop planning has to match real buyer demand before the first seed goes in. For a hydroponic farm, the starting mix is 30% romaine lettuce, 25% arugula, 20% basil, 15% mint, and 10% kale, so the opening crop list fits short cycles, predictable quality, and buyer fit.
Year 1 yield assumptions are 10,000 romaine, 8,000 arugula, 6,000 basil, 5,000 mint, and 9,000 kale, or 38,000 units before loss. Using a 5% planning loss cuts that to about 36,100 units. The farm also needs six harvest months in the calendar, or first-week promises can outrun supply.
Lock The Six-Month Calendar
Before opening, tie the crop plan to buyer demand, pack sizes, and delivery cadence. Here’s the quick math: if the plan says 38,000 units but you reserve 5% for loss, you should sell against 36,100, not the gross number. That keeps the first harvest from creating short shipments or rushed substitutions.
Document the crop mix, seeding dates, harvest windows, and who signs off on volume changes. One clean rule helps: if a buyer needs steady basil, don’t overload the mix with crops that mature faster but don’t match the order book. That protects opening-day service and keeps cash needs tied to real output.
- Confirm buyer demand by crop.
- Plan around six harvest months.
- Hold back 5% for yield loss.
- Match pack sizes to orders.
- Track planned versus harvested volume.
Compliance And Food Safety Readiness
Compliance and Food Safety Readiness
If the farm opens before local permits and food safety records are ready, day-one sales can stall. Hydroponic produce rules can change by state, county, city, and buyer type, so zoning, business registration, produce-handling rules, labeling, packaging, and sales tax treatment have to match the exact site and sales channel.
The main risk is simple: buyers can reject product if water test records, nutrient logs, cleaning logs, lot records, and delivery records are missing. The rules can also shift if produce is washed or handled after harvest, so compliance work has to be in place before the first pickup, not after the first order.
Lock the record set before first harvest
Start with the farm address, sales channel, packaging format, and buyer documentation needs. Then verify the permit path and assign one person to keep daily records current so paperwork does not slip when harvest starts.
- Confirm zoning and business registration.
- Track water, nutrient, and cleaning logs.
- Keep lot and delivery records.
- Check labels, packaging, and sales tax rules.
- Test buyer paperwork before opening.
Buyer Pipeline And Sales Channels
Buyer Pipeline Before First Cut
Sales channels need to be lined up before the first harvest, or the farm can open with product and nowhere to move it. For hydroponic greens, that means pre-selling to restaurants, grocers, farmers markets, CSA customers, meal-prep companies, and local distributors so day-one output has a buyer and a delivery plan.
Here’s the quick risk: if you grow without purchase intent, you tie up cash in crops that may miss the right pack size, price, or delivery window. At Year 1 prices of $15 romaine lettuce, $18 arugula, $22 basil, $20 mint, and $16 kale, weak demand fit can turn a clean harvest into waste fast. One line matters most: no buyer pipeline, no real launch.
Pre-Sell, Then Plant
Before opening, sample product early, confirm pack sizes, agree on delivery cadence, and test price acceptance with each channel. Buyers for fresh produce want consistent harvest volume, clean packaging, freshness, and reliable delivery windows, so the sales plan must match what the farm can actually ship from week one.
- Lock target buyers before harvest.
- Confirm pack sizes by channel.
- Set delivery days and windows.
- Test pricing on each crop type.
- Track sample feedback and reorders.
If these steps slip, first revenue slips too, and unsold greens can pile up before the farm has stable cash flow. The opening plan should treat buyer commitments as a launch input, not a later sales task.
Staffing And Harvest Workflow
Staffing And Harvest Workflow
This launch driver decides whether the hydroponic farm can turn crops into repeatable daily work from day one. The team needs to know seeding, transplanting, nutrient monitoring, pest checks, harvesting, washing if used, packaging, cleaning, deliveries, and recordkeeping before the first commercial harvest, or opening week becomes trial and error.
The biggest risk is one person holding all grow knowledge. If training waits until buyer orders start, product quality, food safety logs, and delivery timing can slip at the same time. The workflow has to match the crop schedule, pack sizes, routes, and records so the farm can fill orders without stopping production to figure out the next step.
Train Before First Harvest
Build SOPs for water checks, nutrient dosing, sanitation, harvest handling, and rejected crop tracking before the first cut. Assign one owner for each step, then run a mock harvest so the team knows who cuts, who packs, and who logs the lot.
- Train staff before commercial harvest.
- Match pack sizes to orders.
- Lock routes and cutoff times.
- Keep logs current every shift.
If washing is part of the workflow, confirm sink space, clean zones, and drying time now, not after orders start. That helps protect opening timing and keeps first-day fulfillment from stalling on a missing step.
Related Products
- Hydroponic Farming Porter's Five Forces Analysis
- Hydroponic Farming BCG Matrix
- Hydroponic Farming Business Model Canvas
- Critical KPIs for Scaling Hydroponic Farming Operations
- Hydroponic Farming Business Plan Template in Pre-Written Word
- How to Increase Hydroponic Farming Profitability in 7 Practical Strategies
- Running Costs for Hydroponic Farming: A Monthly Financial Breakdown
- Hydroponic Farm Startup Costs For A 1-Hectare Leafy Greens Launch
- Hydroponic Farming Financial Model Template in Excel
- How Much Does a Hydroponic Farm Owner Make on 1 Hectare?
- How to Write a Business Plan for Hydroponic Farming
- Hydroponic Farming Marketing Mix
- Hydroponic Farming Marketing Plan
- Hydroponic Farming Business Proposal
- Hydroponic Farming PESTEL Analysis
- Hydroponic Farming Pitch Deck Example Editable PPTX
- Hydroponic Farming Business SWOT Analysis
- Hydroponic Farming Value Proposition Canvas
Frequently Asked Questions
Start with the crop plan and buyers, not the equipment catalog The researched base case uses 1 hectare, 5 crops, and a 5% Year 1 yield loss assumption Secure the site, test water, install systems, run a crop trial, and get buyer commitments before the first commercial harvest
