How To Start A Salt Delivery Service In 6 To 12 Weeks

Salt Delivery Service Opening Plan
Fully Editable
Instant Download
Professional Design
Pre-Built
No Expertise Is Needed
Salt Delivery Service Bundle
See included products:
Financial Model iSalt Delivery Service Bundle Financial Model template included in this product.
$149 $109
ADD TO YOUR ORDER
Business Plan iSalt Delivery Service Bundle Business Plan template included in this product.
$79 $59
Pitch Deck iSalt Delivery Service Bundle Pitch Deck template included in this product.
$49 $29
YOU SAVE $0 TODAY
30-Day Money-Back Guarantee
Created by a Former CFO
Updated for 2026
One-Time Purchase
Description

You’re launching a local delivery operation where salt supply, storage, trucks, and routes have to work before the first order This salt delivery service launch plan covers vendor sourcing, vehicle readiness, storage, sales channels, and opening steps over a 6 to 12 week setup window, with the financial model used to validate timing, revenue ramp, and cash runway


Time to Open8-12 weeksLaunch runway
Launch Sequence6 stagesSuppliers first
Key BottleneckSupply gateSupply and storage
First Revenue StepPre-season contractsRoute book open

Launch timeline

This is a short web summary of the salt delivery launch plan; the XLSX export holds the detailed Gantt chart.

Launch scheduleWeek 1Week 2Week 3Week 4Week 5Week 6Week 7Week 8
Legal & Compliance
Week 1-45 tasks
  • Entity filing
  • Tax setup
  • Permit filing
  • Insurance bind
  • Policy review
Suppliers & Inventory
Week 1-65 tasks
  • Source suppliers
  • Sample review
  • Lead-time confirm
  • Reorder rules
  • First stock order
Storage & Equipment
Week 1-65 tasks
  • Lease warehouse
  • Rack layout
  • Install racks
  • Set loading flow
  • Test equipment
Vehicles & Insurance
Week 1-64 tasks
  • Order fleet
  • Bind vehicle policy
  • Register vehicles
  • Inspect trucks
Sales Pipeline
Week 2-85 tasks
  • Target zip list
  • Build offer sheet
  • Start outreach
  • Confirm pre-sells
  • Open checkout
Routing & Staffing
Week 2-85 tasks
  • Hire manager
  • Hire crew
  • Set routes
  • Train dispatch
  • Run launch drill

Planning note: Timing assumes a lean local opening in 6 to 12 weeks. Slip in supplier lead time, covered storage, loading flow, or truck readiness can push first revenue.



Why test the launch plan before buying inventory?

Use the Salt Delivery Service Financial Model Template to test launch timing, cash needs, and break-even logic.

Financial model highlights

  • Inventory, staffing, and trucks
  • Route density and truck use
  • Revenue ramps to $1.693M
  • Breakeven in Month 5
  • Payback in 16 months
  • Cash floor: $820k

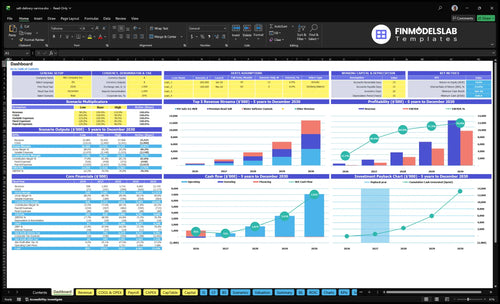

Salt Delivery Service Financial Model dashboard summarizes key KPIs, runway/cash and performance with a dynamic dashboard, highlighting investor-ready charts and solving cash-flow blind spots.

How do you get customers for a salt delivery business?


If you're starting a Salt Delivery Service, get customers from pre-sold routes, quoted bulk deliveries, and repeat accounts before you spend hard; see How To Start Salt Delivery Service Business?. With a $45,000 Year 1 marketing budget and $15 CAC, paid spend can fund about 3,000 new customers if the cost holds. Repeat sales matter too, with a 24-month lifetime and 0.30 orders per month per repeat customer in Year 1.

Icon

First buyers

  • Start with pre-sold routes
  • Quote bulk deliveries first
  • Target repeat accounts early
  • Sell before heavy ad spend
Icon

Best channels

  • Use local search
  • Work referral partners
  • Push pre-season contracts
  • Offer recurring softener plans

How long does it take to start a salt delivery business?


Starting a Salt Delivery Service usually takes 6 to 12 weeks for a lean local launch. The real order is supplier approval first, then storage and loading, then truck insurance and compliance, then routing and pre-sales, with setup pieces like racking in Month 1 to Month 3, forklift in Month 2 to Month 4, and security in Month 3 to Month 4. If onboarding runs long, you can miss the winter salt spike or burn cash before breakeven in Month 5.

Icon

Fast launch path

  • Get supplier terms signed first
  • Set storage before routing
  • Insure the truck before deliveries
  • Start pre-sales early
Icon

Setup timing

  • Racking: Month 1 to 3
  • Forklift: Month 2 to 4
  • Security: Month 3 to 4
  • Breakeven risk: Month 5

What are the biggest salt delivery business mistakes?


The biggest mistakes in Salt Delivery Service are underestimating winter demand, weak supplier terms, poor storage access, overloaded routes, inadequate insurance, and launching before demand is pre-sold. Here’s the quick math: Year 1 revenue is $588,000, variable costs run 199%, core wages are about $203,000, fixed facility and systems costs are $7,300 a month, and fuel and tolls can hit 50% of revenue fast. Keep backup suppliers, store salt dry, cap the first delivery radius, verify payload limits, and quote recurring accounts first.

Icon

Launch risks

  • Winter demand spikes fast.
  • Weak supplier terms squeeze margin.
  • Bad storage ruins product.
  • Overloaded routes raise fuel costs.
Icon

What to fix first

  • Lock backup suppliers.
  • Keep salt dry.
  • Cap the first delivery radius.
  • Train drivers on heavy loads.



Confirm what must be ready before accepting salt delivery orders

Launch readiness checklist

Use this go-live approval checklist before opening to confirm the salt delivery service is ready for launch.

Compliance
  • Registration completeCritical

    You need a legal entity before contracts, insurance, and vendor accounts.

  • Insurance bundle boundCritical

    Commercial auto, general liability, and cargo cover must be active before deliveries.

  • Storage rules clearedHigh

    Salt storage and handling need local approval to avoid launch delays or fines.

Site
  • Covered storage readyCritical

    Dry storage keeps salt from clumping and protects inventory quality.

  • Lease approvedHigh

    The warehouse rent must be locked before fixed cost planning and stocking.

  • Loading area checkedHigh

    Safe loading space cuts damage, delays, and dock bottlenecks.

Suppliers
  • Supplier account approvedCritical

    No supplier account means no stock, so first orders cannot ship.

  • Purchase terms signedCritical

    Clear terms protect cash flow and avoid blocked deliveries.

  • Payload limits confirmedHigh

    Truck load limits must match product weight so routes and pricing stay honest.

Fleet
  • Trucks insuredCritical

    Vehicles need coverage before any customer delivery leaves the yard.

  • Loading gear stagedHigh

    Forklift, pallet tools, and bags must be ready to move salt safely.

  • Vehicle compliance clearedHigh

    Road-legal trucks reduce stop risk and keep the launch schedule intact.

Systems
  • Ordering liveCritical

    Customers need a working way to place orders before launch.

  • Payments testedCritical

    Payment must work on day one so cash starts coming in cleanly.

  • Routes mappedHigh

    Mapped routes support on-time drops and lower fuel waste.

Launch
  • Dispatch process rehearsedCritical

    A clear dispatch flow avoids missed stops and handoff errors .

  • Staff training doneHigh

    Drivers, warehouse staff, and support need the same playbook.

  • First quotes sentCritical

    Pre-sold demand lowers launch risk and shows the market will buy.

  • Go-live signoff completeCritical

    Final signoff should confirm storage, trucks, systems, and demand are ready.

Planning note: Readiness depends on local rules, supplier terms, storage, trucks, and first customer demand.

Which launch drivers matter most before opening?

1Supplier Reliability
Backup source

Approved suppliers and backup stock keep openings from stalling on winter shortages.

2Storage Capacity
Dry load bay

Dry, zoned storage speeds loading and cuts wet-product claims and missed routes.

3Vehicle Readiness
$85K fleet

Trucks, insurance, and route rules must clear before day-one deliveries can start.

4Route Density
Route software

Clustered stops and route software reduce driver hours and make same-day service workable.

5Pre-Sales Pipeline
$45K ads

Pre-season quotes and recurring accounts fill trucks faster and limit dead stock.

6Seasonal Cash
$820K M6

Runway needs to cover the Month 6 low point, or inventory buys choke growth.


Supplier Reliability


Supplier Access Ready

Supplier reliability is the first gate. If you can’t get bagged and bulk salt on time, you can’t promise deliveries, fill subscriptions, or sell ahead of winter. The readiness signal is an approved supplier account, known order minimums, clear lead times, and at least one backup source.

Quote water softener crystals, premium road salt, and pet-safe ice melt, then confirm delivery or pickup terms. Set reorder points before launch so inventory matches the Year 1 sales mix of 400%, 350%, and 250%. The main risk is a winter shortage or supplier terms that tie up too much cash in stock.

Pre-Book Salt Before Selling

Lock the supply plan before taking orders. Ask each supplier for the minimum buy, standard lead time, payment terms, and backup coverage. Then test one full order cycle so you know how fast stock moves from quote to pickup or drop-off. Missing this step can delay opening or cause day-one stockouts.

  • Get written pricing and minimums.
  • Confirm one backup supplier.
  • Set reorder points by SKU.
  • Match stock to the Year 1 mix.
1


Storage And Loading Capacity


Dry, Fast Loading Space

Salt has to stay dry, close to the truck, and easy to move. The site needs zoned storage, covered or moisture-protected space, racking, forklift access, and a clear driveway path so staff can stage inventory without blocking routes. If bags get wet or the layout slows loading, opening slips and first-day orders get harder to fulfill.

The cost is not small. Source figures show $4,500 monthly warehouse rent, $600 utilities, $15,000 for a forklift, and $12,000 for racking and storage systems. That is $27,000 in equipment plus $5,100 a month before inventory, so the floor plan and loading flow have to work on day one.

Stage Stock Before First Dispatch

Test the full path from receiving to truck loading before launch. Verify pallet flow, aisle width, and safe driveway movement so the team can load without re-handling bags. Staged inventory should match the dispatch order, because a slow morning load can cut deliveries and push the day behind before the first stop leaves.

Document the layout, assign the loader, and run a dry test with the heaviest order mix. If the space cannot keep product dry and easy to load, fix that before taking bookings. One wet pallet or blocked route can turn into claims, delays, and fewer completed deliveries.

  • Confirm moisture-protected storage.
  • Mark pallet and truck lanes.
  • Keep driveway turns clear.
  • Stage inventory by route.
2


Vehicle, Insurance, And Compliance Readiness


Vehicle, Insurance, and Rules

For a salt delivery business, the truck is the launch gate. You need payload matched to bagged and bulk loads, a liftgate or pallet jack plan, and insurance in force before you take orders. The model assumes an $85,000 delivery truck fleet, plus $1,200 monthly vehicle insurance and $450 monthly general liability.

DOT, CDL, and state rules depend on vehicle size, load, route, and local law, so confirm them before you book deliveries. Add cargo coverage and a documented driver process for loading, transport, and drop-off. That cuts day-one risk from safety issues, claims, and failed service.

Pre-Launch Checks

Test the truck or trailer against the real load mix, not a guess. Check loading access, safe unloading, and whether one person can move product without slowing dispatch. If the vehicle setup does not fit the route plan, opening slips and early labor cost goes up.

  • Match capacity to bagged loads.
  • Confirm liftgate or pallet jack.
  • Review cargo coverage limits.
  • Verify DOT and CDL triggers.

Keep the launch date tied to these checks. If insurance binding or vehicle approval slips, push the first order date back instead of selling delivery windows you cannot safely cover. That protects cash and keeps first routes on time.

3


Route Density And Dispatch


Route Density And Dispatch

If early orders are scattered, the business can open late in practice even if trucks are ready. A tight service area, clustered orders, and defined delivery windows turn first-month sales into routes that a driver can actually finish, instead of long, wasteful drives that burn hours and fuel.

The model assumes $200 per month for route optimization software and fuel and tolls at 50% of revenue in Year 1. That makes dispatch discipline a launch requirement, not a nice-to-have. Water softener salt can smooth demand outside winter, but road salt needs fast storm dispatch, so weak routing can delay service, raise overtime risk, and hurt day-one delivery reliability.

Set the route before you sell the route

Before opening, lock the service radius, delivery days, and handoff process, then test whether the same stop list can be covered in one shift. The ready signal is a repeatable schedule with a dispatcher or driver handoff that tells the team what loads, windows, and stops go out each day.

  • Limit orders to clustered zip codes.
  • Use fixed delivery windows.
  • Map storm-day fast dispatch rules.
  • Separate softener and road salt routes.
  • Track stop count per truck day.
  • Reject scattered stops that waste drive time.

What this setup protects is simple: truck utilization, driver time, and first-week customer trust. If orders arrive before routing is defined, the business can still have inventory and a truck, but not a workable opening plan.

4


Pre-Sales And Customer Pipeline


Booked Demand Before Launch

If you open with no quotes or booked orders, you guess at truck routes, inventory, and staffing. With a $45,000 Year 1 marketing budget and $15 CAC, the model can support about 3,000 customers ($45,000 ÷ $15) if the funnel is live before buying too much salt.

This launch driver matters because pre-season outreach turns demand into a real opening plan. Build for commercial quotes, recurring homeowner softener routes, snow contractor and property manager leads, plus local search and referral partners. The model’s 450% repeat customers and 24-month repeat lifetime make refill capture more important than one-time sales.

Build the Quote Funnel Early

Start with quote forms, a published service radius, and delivery windows you can actually hit. Confirm softener refill interest and route timing before inventory buys get large, or you risk dead stock, idle trucks, and a launch that looks open but cannot serve fast.

One clean rule: book demand before you stock deep. Track each lead type separately so you know where first revenue will come from and which accounts need follow-up before opening day.

  • Publish service radius first.
  • Build quote forms now.
  • Confirm delivery windows early.
  • Track referrals by customer type.
5


Seasonal Inventory And Cash Planning


Seasonal Inventory And Cash

For a salt delivery business, inventory timing is the launch gate. Winter spikes, supplier shortages, and off-season softener demand all hit cash at different times, so you need agreed lead times, reorder points, and route capacity by week before you sell the first bag. Launching before peak demand cuts stockouts and keeps day-one orders real.

The cash plan matters as much as the stock plan. With breakeven in Month 5, payback in 16 months, Year 1 EBITDA of $104,000, and a $820,000 minimum cash point in Month 6, the business can look healthy and still run short if buys come too early or in the wrong mix. No salt on site means no delivery on day one.

Pre-Buy Before Peak Weather

Build the buying calendar around winter storms, not monthly averages. Confirm supplier minimums, delivery windows, and backup sources, then set inventory floors for road salt and water softener salt. The disclosed cost stack is heavy: 95% procurement, plus 25% bags, 50% fuel and tolls, and 29% payment fees, so small timing misses can trap cash fast.

  • Test cash runway before launch.
  • Match buys to weekly route capacity.
  • Document reorder points and lead times.
  • Separate winter and softener demand.

What this plan hides is simple: if inventory lands late, orders slip; if it lands too early, cash sits in stacks of salt. Keep the first season tight, because the model only works if inventory, dispatch, and cash all move together before the first snow event.

6


Frequently Asked Questions

Start with supply, storage, trucks, routes, and pre-sales The researched launch window is 6 to 12 weeks for a lean local setup Use the model to test Year 1 revenue of $588,000, 350 units per order, and breakeven in Month 5 before locking heavy inventory or fleet commitments
