How To Open A Cable Wakeboarding Park: 8-Month Launch Path
Cable Wakeboarding Park
You’re building a site-dependent water sports business, so the launch starts with land, water, permits, and cable installation before paid riders ever check in This guide covers the 8-month modeled build window, opening checklist, staffing, safety, first revenue, and the financial checks behind a Year 1 revenue plan of $123 million
Time to Open8 monthsSetup windowLaunch Sequence6 stagesSite control firstKey BottleneckPermit gateApproval pathFirst Revenue StepPre-sold passesBooking live
Launch timeline
Short web summary of the launch plan; the XLSX export carries the detailed Gantt chart.
What do you need to open a cable wakeboarding park?
To open a Cable Wakeboarding Park, you need a controlled water site, approvals, a cable system, trained staff, safety coverage, insurance, waivers, and a booking or POS flow before selling the first pass; use How To Write A Cable Wakeboarding Park Business Plan? to map those items into a launch plan. The first money test is whether $35 hourly passes, $85 day passes, $750 season passes, rentals, cafe sales, and coaching can cover safe staffing and open hours.
Launch must-haves
Secure a suitable lake or pond
Get legal site control
Clear zoning and environmental approvals
Install cable system, docks, and obstacles
Year 1 setup
Staff 1 general manager
Hire 3 cable operator FTE
Add 2 instructors and 2 safety FTE
Cover guests with 2 service or cafe FTE
How do cable wake parks get first customers?
Cable Wakeboarding Park gets first customers by selling founding memberships, season passes, day-pass bundles, beginner lesson packages, youth camps, and opening-weekend events before full launch. If you want the launch playbook, see How Do I Launch A Cable Wakeboarding Park Business?. With $35 hourly passes, $85 day passes, and $750 season passes, Year 1 volume of 12,000 hourly passes, 4,500 day passes, and 150 season passes implies about $915,000 in ticket revenue.
Start with pre-sales
Sell founding memberships first
Push season passes early
Bundle day passes and lessons
Add rentals, clinics, and test rides
Find local riders
Reach local wakeboarding groups
Partner with gyms and schools
Work with tourism partners
Run opening-weekend events
How long does it take to open a cable wake park?
A Cable Wakeboarding Park usually takes Month 1 to Month 8 from project start, with the critical path running through site approval, environmental review, cable equipment ordering, and lake excavation plus liner work in Month 1 to Month 3. The cable system itself often runs from Month 1 to Month 6, while obstacles, clubhouse, and POS can stretch through Month 8; don’t open until staff training and emergency procedures are done.
Build path
Month 1 to Month 3: approvals and review
Month 1 to Month 3: cable ordering and excavation
Month 1 to Month 6: cable system install
Month 4 to Month 7: obstacles and fit-out
Delay risks
Permits can slow the start
Weather can push field work
Inspections can add rework time
Failed commissioning tests can delay opening

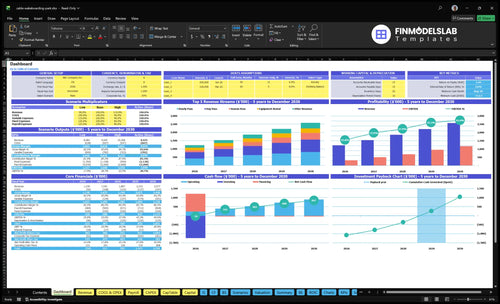

Cable Wakeboarding Park Financial Model
5-Year Financial Projections
100% Editable
Investor-Approved Valuation Models
MAC/PC Compatible, Fully Unlocked
No Accounting Or Financial Knowledge
Confirm the park is safe, legal, staffed, and sellable before paid riders
Launch readiness checklist
Use this go-live approval checklist to confirm the park is ready before opening.
1Site rights
Lease or title securedCritical
You need legal control of the site before any build or customer work starts.
Zoning approval confirmedCritical
Water sports use must be allowed before you spend on build-out.
Water access approvedCritical
The park cannot open without confirmed access to the water area.
Environmental review clearedHigh
Environmental signoff matters if local rules require review for site work.
2Cable system
Cable commissioned and testedCritical
An untested cable is a launch blocker because it drives ride safety.
Docks and features installedHigh
Docks, kickers, and rails must be in place before riders arrive.
Rescue gear stagedCritical
Boats, throw gear, and rescue tools need to be ready for fast response.
3Safety
Insurance boundCritical
No insurance confirmation means you should not open to riders.
Emergency plan approvedCritical
A weak rescue plan raises injury risk and slows incident response.
Incident log readyMedium
Incident logs help track claims, patterns, and safety fixes.
Safety signage postedHigh
Clear signs reduce guest confusion around rules, zones, and hazards.
4Guest flow
Booking system liveCritical
Guests need a working path to reserve time before opening day.
POS payments testedCritical
The payment flow must work for passes, rentals, and add-ons.
Capacity limits setCritical
Bookings must stay within safe ride, staff, and water capacity.
5Staffing
Core staff hiredCritical
Year 1 needs a general manager, cable operators, instructors, safety staff, and guest service staff.
Operators trainedCritical
Trained operators reduce cable faults and rider risk on day one.
Shift schedule setHigh
Coverage must match forecast demand and keep safety roles filled.
6Launch signoff
Year one cash runway checkedCritical
The model shows a minimum cash of -$112k in Month 8, so runway matters.
Pricing model approvedHigh
Pass pricing must support the Year 1 revenue plan and fixed overhead.
First revenue offer readyHigh
The first offer should be clear for hourly, day, season, and add-on sales.
Go-live signoff completeCritical
Final signoff should confirm no open blockers before opening month.
Which launch drivers decide opening day?
1Site Permits
Gate
Legal site control and zoning approval come first, or equipment spend can get stranded.
2Cable System
6 mo, $450K
The cable system is the launch core; late orders or weak commissioning delay paid rides.
3Water Flow
M1-7
Excavation, docks, obstacles, parking, and guest paths must finish cleanly or rider flow stalls.
4Safety Team
10 FTE
Insurance, drills, waivers, and rescue training cut incident risk before the first riders.
5Pre-Sales
12K/4.5K/150
Booked passes and lessons fill first-week slots, so you don't open to empty lanes.
6Ops Setup
M6-8
Systems need to match capacity, or busy sessions create check-in errors and weak revenue tracking.
Site And Permitting Readiness
Site Control and Permits First
If the park does not have legal control of the lake or pond site, the launch is not ready. You need a site that fits the ride plan: usable shape and depth, shoreline access, parking, utilities, neighbor fit, zoning path, and environmental review status. If any one of those is weak, opening on time slips and day-one guest flow gets messy.
The big risk is buying or ordering equipment before the site is approvable. That can leave you with stranded build costs and a broken vendor schedule. Keep the land lease or purchase, survey, water rights or access review, zoning filing, environmental documentation, and site plan approval moving in sequence.
Lock the Site Before the Build
Start with documents, not hardware. Verify lease or purchase control, survey boundaries, and any water access rights before you spend on the cable system or shoreline work. That keeps your build plan tied to an approvable site, not a wish list.
Use a simple gate: no major equipment commitment until zoning, environmental review, and site plan approval are far enough along to support the opening date. If parking or utilities are still unresolved, fix those first because they affect check-in, safety, and first-day capacity.
Control the site before ordering equipment.
Finish survey and access review early.
File zoning and environmental docs in order.
Hold vendor slots only after approval confidence.
1
Cable System Procurement And Installation
Cable System Installation
This is the gate that decides whether the park can open on time. The full-size electric cable system is budgeted at $450,000 and scheduled from Month 1 to Month 6, so any slip in ordering, tower and anchor work, power setup, or crew timing can push the first paid ride back.
Paid riding should not start until pulls, stops, turns, and operator controls are tested and signed off. If commissioning fails, the park may have staff, marketing, and customers ready but no safe way to run sessions on day one.
Lock the install sequence early
Start with the selected system type, vendor slot, tower and anchor plan, power plan, delivery schedule, installation crew timing, testing plan, and commissioning checklist. That is the real readiness stack. Miss one item and the install can stall even if the site is otherwise ready.
Keep the launch plan tied to test completion, not delivery date. The founder should verify the commissioning window, assign one owner for vendor follow-up, and hold cash for the full Month 1 to Month 6 build so the park does not open with unfinished controls or unsafe riding conditions.
Confirm vendor slot before site work.
Match power plan to system load.
Book crew before delivery.
Test controls before selling rides.
2
Water, Docks, Obstacles, And Guest Flow
Guest Flow And Shoreline Buildout
This driver matters because riders can’t start until there’s a safe path from check-in to gear to start dock to exit. If docks, walkways, changing areas, and rental storage aren’t ready, opening slips and day-one service gets clumsy. The quick read is simple: lake excavation and liner must finish in Month 1 to Month 3 before the rider path can work.
The rest has to line up with the build schedule: obstacles in Month 4 to Month 7 and parking and landscaping in Month 3 to Month 7. The main bottleneck is unsafe guest movement or an incomplete shoreline setup. If signage or lighting is late, staff end up managing traffic instead of serving riders.
Lock The Rider Path Early
Map the full guest route before you set the opening date: arrival, check-in, waivers, gear issue, dock access, rider return, storage, and exit. Document where docks, walkways, and barriers go, then test the flow with staff before guests arrive. One clean path beats a polished site that still feels confusing on day one.
Assign owners for dock setup, rental storage, signage, and changing areas. If a cafe is planned, keep food traffic separate from rider traffic so lines don’t block the dock. Verify the shoreline work is complete, the route is visible, and parking can move guests without crossing active rider paths.
Finish excavation and liner first.
Confirm dock and return-path widths.
Test signage from parking to dock.
Keep food lines off rider routes.
3
Safety, Insurance, And Staff Training
Safety, Insurance, and Training
This is the non-negotiable launch gate. The park should not open until liability and property insurance are confirmed, the emergency action plan is written, and rescue gear, waivers, rider briefings, incident logs, and the daily opening checklist are all in place. If any of that is weak, opening slips and insurer confidence drops before the first paid ride.
Year 1 staffing needs are specific: 3 cable operator FTE, 2 instructor FTE, and 2 lifeguard and safety staff FTE. The real risk is opening before the team has drilled the process. That can turn a simple rescue or rider issue into a shutdown, a claim, or a bad first-day experience.
Drill the day-one safety stack
Before launch, verify the team can run the same sequence every morning: inspect rescue equipment, review the opening checklist, brief staff, confirm waivers, and test the incident log process. Keep the opening gate tied to proof, not intent. If the team cannot do it without help, the park is not ready.
Confirm insurance before scheduling riders
Train operators on controls and shutdowns
Test rescue steps and rider retrieval
Use daily checklists every opening
Log incidents the same day
4
Pre-Opening Demand And Memberships
Booked Capacity
Pre-sold riders are the real launch gate. A cable wake park can be staffed and fully built, but if season passes, day-pass bundles, and opening-weekend reservations are thin, you open with empty rider slots and fixed costs still running. That hurts day-one cash, makes the site look underused, and can slow word of mouth.
Here’s the quick math: 12,000 hourly passes at $35 is $420,000; 4,500 day passes at $85 is $382,500; 150 season passes at $750 is $112,500. That is $915,000 in pass revenue before $165,000 in equipment rental and $55,000 in coaching and clinics. Weak pre-sales push the opening date risk onto the first month.
Fill The Calendar
Before opening, make sure every sale type maps to a real slot: camp deposits, local partner referrals, and lesson packages should flow into the booking calendar, not just a spreadsheet. Track paid capacity by week, so a sold pass becomes a checked-in rider with gear, staff, and dock time ready.
Test the full path early: payment, waiver, reservation, and confirmation. If opening-weekend reservations are light, cut back on broad ads and push local clubs, schools, and tourist partners until the first two weeks are visibly booked.
5
Booking, Pricing, Capacity, And Model Checks
Booking And Capacity Controls
When riders book online, sign digital waivers, and move through timed slots, the park controls flow instead of chasing it. This launch driver covers POS (point of sale), pricing, capacity rules, rental tracking, lesson scheduling, staff rota, opening hours, and refund policy. If it slips, you may still open the site, but not serve customers cleanly on day one.
The model needs this locked before launch because IT infrastructure and POS are planned for Month 6 to Month 8. With software and POS subscriptions at $600 per month and fixed overhead at $18,800 per month, weak setup hides true demand and strains cash fast. The plan also shows $123 million Year 1 revenue, so slot rules and model checks must match real capacity, or the forecast is overstated.
Lock The Flow Before Selling Slots
Set the operating rules before sales go live. Match slot length to rider capacity, tie rentals to each booking, and assign staff by session so check-in, waivers, gear handoff, and lessons all fit the same flow. One booking, one waiver, one slot, one staffing plan.
Cap riders per session.
Test online booking to check-in.
Link rentals to each rider.
Publish refund rules early.
Run a weekly model check against actual bookings, rentals, lesson load, and staff rota. If busy sessions are oversold or understaffed, wait times rise and the first weekend gets messy. Compare booked riders to hourly capacity before opening day, then again through Month 6 to Month 8, so the $18,800 monthly overhead is covered by a realistic operating plan.
Start with the water site, not the equipment Secure site control, confirm zoning and environmental requirements, then schedule the cable system, lake work, docks, safety plan, insurance, staff training, and booking setup In the model, major build work runs through Month 8, with Year 1 revenue planned at $123 million
Plan for a multi-month process because approvals and installation drive the date The modeled build window runs Month 1 through Month 8 The cable system runs Month 1 to Month 6, while clubhouse, cafe, and POS work finish by Month 8 Permits can push this longer
Yes, staff readiness comes before paid riding The Year 1 staffing plan includes 1 general manager, 3 cable operator FTE, 2 instructor FTE, 2 safety FTE, and 2 guest service or cafe FTE Operators, safety staff, waivers, rescue equipment, and emergency procedures should be tested before soft opening
The biggest delays are site approval, environmental review, weather, utility readiness, vendor scheduling, cable commissioning, and inspections A late POS setup can also hurt opening-week sales The model shows minimum cash dipping to negative $112,000 in Month 8, so delays need cash runway
Start pre-selling capacity that matches your staffing and safe rider slots Use founding memberships, $750 season passes, $85 day-pass bundles, $35 hourly passes, lesson packages, youth camps, rentals, and opening-event bookings Pre-sales prove demand before the park carries full fixed overhead of $18,800 per month
About the author
Noah Quinn
Business Operations Writer
Noah Quinn is a business operations writer at Financial Models Lab who researches how small businesses launch, operate, and earn money. He focuses on first-year business costs and simple business projections for first-time entrepreneurs, helping them move from side project to real business. With a calm, structured approach, he turns broad business ideas into clear planning assumptions that make early decisions easier.
