How To Open A Kosher Restaurant In 4-9 Months With Certification

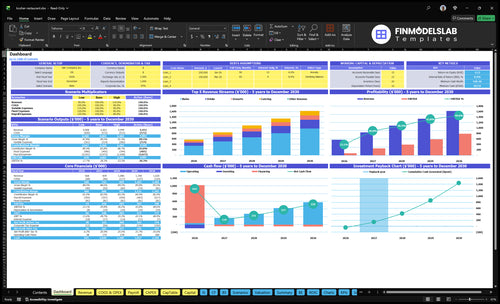

You’re opening a food business where trust starts before the first order This kosher restaurant launch plan covers the 4-9 month path from certification and permits to kitchen setup, staffing, suppliers, and first customers, with financial validation using a 60-month model as support
Time to Open6 monthsLaunch runwayLaunch Sequence6 stagesCertify firstKey BottleneckKashrut gateSupervision setupFirst Revenue StepPre-ordersCommunity sales
Launch timeline
Short web summary of the launch plan; the XLSX export includes the detailed Gantt Chart.
A Kosher Restaurant can go wrong fast if certification scope is unclear, suppliers aren’t approved, or staff treat kosher supervision like a side task. The biggest launch risk is opening before the kitchen, menu, and daily workflow all match the rules.
Common launch mistakes
Certification scope isn’t locked.
Suppliers aren’t pre-approved.
Staff miss kosher SOPs.
Kitchen flow breaks the line.
What to fix first
Lock supplier approvals before buying.
Train staff on standard procedures.
Test POS and delivery channels.
Run a soft opening first.
How do you get first customers for a kosher restaurant?
Start before opening: a Kosher Restaurant gets its first customers through synagogue outreach, local Jewish organizations, pre-opening reservation lists, tasting events, catering pilots, delivery listings, and soft-opening feedback. If you’re planning launch spend, read How Much Does It Cost To Open A Kosher Restaurant? so the first sales prove demand, not just fill seats. The Year 1 model assumes 600 weekly covers and a 10% catering sales mix.
Get the first diners
Ask synagogues to share opening invites.
Work local Jewish groups and lists.
Build a pre-opening reservation list.
Run tasting events and catering pilots.
Test demand fast
Use soft openings for feedback loops.
Track demand by daypart, not just totals.
Check supplier reliability before scaling.
If pre-orders are weak, cut menu scope.
Do you need kosher certification for a restaurant?
Yes, the Kosher Restaurant needs kosher certification if it will market itself as kosher; certification drives opening-day trust, supplier approval, kitchen setup, staff rules, and menu scope. Treat it as a launch dependency, not a late marketing item, and pair it with What Is The Most Important Indicator For The Success Of The Kosher Restaurant? when tracking demand and repeat visits.
Do it before launch
Approve 100% of suppliers first
Check every ingredient at intake
Set kitchen flow before equipment layout
Print menus only after approval
Control the risk
Use a mashgiach, the kosher supervisor
Train staff before soft-opening sales
Lock procedures before service starts
Confirm rules with the certifying authority
Key Takeaways
Certification must be locked before any launch changes.
Kitchen layout needs approval before equipment spend.
Proven community demand beats signing a costly lease.
Staffing works only after procedures and supervision.
Kashrut Certification And Supervision
Kosher Certification
Certification is the gate to opening as a kosher restaurant. The business can’t credibly launch until a certifying authority is confirmed, the supervision schedule is set, the supplier list is approved, and kitchen rules are written. That’s what turns the concept into a real day-one operating plan, not just a menu idea. If this slips, opening moves too, because compliance is part of the product.
Late menu or layout changes are the main risk. The launch work has to cover concept review, ingredient approval, receiving, staff rules, and opening-day supervision. If the kitchen flow changes after approval, the team can face rework, missed sign-off, and avoidable launch delays. Done right, the result is higher trust, fewer compliance surprises, and a cleaner first week.
Freeze Approvals Early
Lock the menu, layout, and supplier list before the final review. Verify every ingredient, write the receiving steps, and assign who checks deliveries and who oversees service on opening day. Keep the approved setup stable so the certifying authority is reviewing the real operation, not a moving target.
Confirm the certifying authority first.
Approve all ingredients before ordering.
Document receiving and storage rules.
Train staff on kosher handling.
Schedule opening-day supervision in advance.
1
Compliant Kosher Kitchen Setup
Build the Kosher Kitchen Right
The kitchen has to match the final kosher concept before inspection, or the opening date slips. A layout that supports equipment use, storage, dishwashing, labeling, prep flow, and meat/dairy controls where applicable is the readiness signal, not just a nice floor plan.
Here’s the quick math: $45,000 of kitchen equipment runs from Month 1-Month 3, $20,000 of leasehold improvements run from Month 1-Month 4, and $2,500 of smallwares run from Month 3-Month 5. If rabbinical review forces redesign, you pay twice and delay training.
Lock the Layout Before You Buy
Verify the full work path before any install: receiving, storage, prep, cooking, dish, and labeled returns. Keep the plan aligned with certification review so equipment placement, sink use, and separation rules don’t need rework after the fact.
Map food flow from delivery to service.
Separate meat and dairy areas clearly.
Approve equipment before ordering.
Test dishwashing and labeling flow.
Assign tasks before opening week.
This setup cuts opening-day mistakes because staff can train on the real workflow. It also keeps cash needs visible: the buildout spend spans Month 1-Month 5, so any late change can push vendor timing, add labor, and slow first revenue.
2
Location And Community Demand
Location and Demand
A kosher restaurant lives or dies on where it opens. The site has to fit observant Jewish households, synagogue access, weekday traffic, catering reach, and a delivery radius that can actually support daily covers. A good location cuts launch risk because it gives you a real first customer base before you spend on lease terms and buildout.
The hard check is tested demand before lease commitment. The model starts at 50 Monday covers, 75 Thursday covers, 110 Friday covers, 120 Sunday covers, and 600 weekly Year 1 covers. If the area cannot support those patterns, rent comes due before revenue does, and Month 4 breakeven gets pushed out.
Verify Demand Before You Sign
Map the trade area first: synagogues, kosher households, schools, offices, and catering accounts. Then test interest with preorders, catering inquiries, and weekday reservation signals. If the data does not show repeat demand on Monday, Thursday, Friday, and Sunday, do not lock a long lease or heavy buildout.
Track three things before opening: delivery radius, competition, and rent as a share of early sales. That keeps the opening plan tied to real traffic, not hope. A site with weaker demand can still work, but only if the fixed cost is light enough to protect cash through the first months.
Confirm community density first.
Test catering before signing.
Match rent to proven covers.
Use weekday traffic as proof.
3
Approved Supplier Chain
Approved Supplier Chain
For a kosher restaurant, the supplier chain is a launch gate, not a back-office detail. Readiness means approved kosher ingredients, verified distributors, backup vendors, known lead times, and menu items matched to supply reality. If those pieces are not locked before opening, the restaurant can miss certification rules and lose dishes on day one.
Here’s the quick math: the model uses $7,000 initial inventory in Month 3, plus 10% Year 1 food ingredients, 2% packaging supplies, and a 10% catering sales mix. One missing approved ingredient in opening week can trigger menu outages, weaker service, and tighter margins right when cash is most fragile.
Lock the vendor list before the menu is final
Start with the approved ingredient list, then map each dish to a verified source. Check lead times, minimums, and backup options for the items that matter most. If a dish depends on one hard-to-find input, cut it or replace it before launch. That keeps opening inventory realistic and protects first-week service.
Confirm approved distributors in writing.
Match menu items to supply reality.
Hold backup vendors for key inputs.
Test receiving before opening week.
Also assign one person to track reorders and the $7,000 opening stock. That lowers the odds of a day-one scramble, keeps menu promises credible, and helps staff serve the same items guests ordered at opening.
4
Staffing And Operating Discipline
Trained Crew, Clear Flow
Staffing and operating discipline is what turns a certified kosher kitchen into a restaurant that can actually open on time and serve day one without chaos. This launch driver covers service flow, kosher handling rules, opening steps, POS use, allergen and menu communication, and coordination with supervision. If these are unclear, the team can’t move fast without making compliance or service mistakes.
The hiring plan is already heavy: 10 owner/manager, 10 lead chef, 10 assistant chef, 20 counter staff, and 10 kitchen assistant, with Year 1 wages at about $22,000 per month. That means payroll starts before service is smooth, so hiring too early can burn cash fast. The real risk is staffing people before procedures are written and tested.
Write It Down, Then Run It
Before opening, lock the basics in this order: written procedures, role assignments, mock service, then final training. The team should know opening steps, kosher handling rules, POS steps, menu language, and who handles supervision on day one. Readiness is not “we hired everyone.” Readiness is trained staff, written procedures, mock service, and assigned opening-week roles.
Use a short pre-open checklist so the first week does not depend on memory. Confirm who opens, who receives product, who talks to guests about allergens, and who fixes a missed item at the POS. One clean line matters here: if the crew can’t repeat the service process, the restaurant is not ready to open.
Write opening steps before hiring more.
Test POS and guest scripts.
Assign supervision contacts by shift.
Run mock service with full stations.
Verify allergen and menu answers.
5
Pre-Opening Sales And Marketing
Pre-Opening Sales
This launch driver matters because it shows real demand before the doors open. For a kosher restaurant, reservation lists, community outreach, catering pilots, delivery setup, and tasting feedback help prove the menu and service model before the full opening signal. That cuts the risk of paying for rent, labor, and inventory with no tested orders.
Here’s the quick math: the source model assumes $18 midweek AOV, $22 weekend AOV, 20% drinks mix, 10% desserts mix, 10% catering mix, 3% Year 1 marketing and promotion, and 4% delivery platform commissions. If pre-opening sales are weak, awareness spend can outrun real demand, and opening day becomes a guess, not a plan.
Test Orders First
Start with tested orders, not broad promotion. Verify the reservation list, confirm catering pilot terms, and make sure delivery setup works before the soft opening. That keeps the team focused on dishes that sell, not on a menu that only looks good on paper.
Track reservation requests by date.
Record tasting feedback by item.
Test delivery fees at 4%.
Price against $18 and $22 checks.
What this hides: if the first sales are all one channel, the launch mix can skew fast. Use soft-opening sales to see what actually moves, then tighten the menu before day one.
