How to Open a Water Park: 18–36 Month Launch Roadmap
Water Park
You’re planning a high-compliance attraction business, so the launch plan has to cover land use, construction, inspections, staffing, ticketing, and first sales before guests arrive This guide shows the practical steps to open a water park in the United States over an 18–36+ month launch window, using the model’s Year 1 demand assumptions of 150,000 day passes, 15,000 season passes, and 5,000 group bookings as validation checkpoints Cost, funding, and owner income need separate deeper analysis
Time to Open18-36 monthsSetup windowLaunch Sequence8 stagesSite controlKey BottleneckPermit reviewApproval pathFirst Revenue StepSeason passesPre-open sales
Launch timeline
Short web summary of the launch plan; the XLSX export contains the detailed Gantt Chart.
Can the Water Park launch model survive opening month?
Before launch, the Water Park Financial Model Template maps opening date, ramp, pricing, add-ons, payroll timing, and cash runway against $320,000 fixed monthly costs.

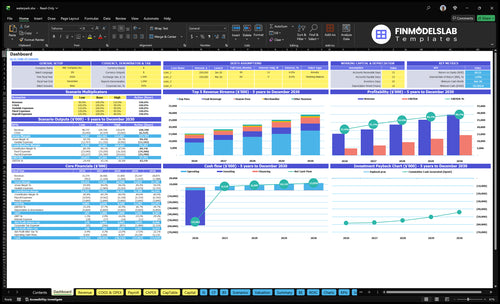

Financial model highlights
Dashboard, opening date, ramp
Day passes, season presales
Group bookings and add-ons
$90M day-pass revenue
$225M season-pass revenue
$225k group bookings
$30M food and beverage
$500k merch, cabanas, lockers
Payroll, maintenance, utilities, insurance
$320k monthly fixed costs
How long does it take to build a water park?
A Water Park usually takes 18–36+ months to build, and the schedule is driven more by permits, engineering, and utility work than by the slides themselves. Site entitlements, pool construction, pump rooms, filtration, drainage, inspections, weather, and seasonal hiring can all push the start date. Delays matter fast once the operating plan is active, because fixed monthly commitments can reach $240,000 from $150,000 rent, $50,000 insurance, and $40,000 maintenance.
Biggest timing drivers
Site entitlements take the longest.
Engineering comes before construction.
Slide manufacturing can add months.
Utility connections slow opening dates.
Why delays hurt
Permits and staffing must align.
Inspections can stop the launch.
Weather can stretch the build.
Active fixed costs stack to $240,000 monthly.
What launch mistakes stop a water park from opening safely?
A Water Park should not open until inspections, lifeguards, water quality, maintenance, crowd flow, ticketing, vendor setup, emergency steps, and food approvals all work in live operations. The staffing check is simple: Year 1 needs 1 head lifeguard, 1 operations manager, 1 maintenance supervisor, 1 guest services supervisor, and 80 seasonal staff; if that coverage does not match guest capacity and hours, delay opening. Safety readiness is daily work, not paperwork.
Stop these launch gaps
Do not skip full safety inspections.
Do not open with weak water checks.
Do not launch untested ticketing.
Do not rely on vague emergency steps.
Check readiness in daily ops
Match lifeguard count to guest load.
Confirm maintenance plans before opening.
Test vendor setup before day one.
Get food service approvals early.
What permits are needed to open a water park?
A Water Park needs a location-dependent US approval stack, not one national permit; see How Is The Water Park's Overall Customer Experience Reflecting Its Core Success? because safety approvals directly affect when tickets can go live. Inspections can still block opening after construction finishes, so budget for $10,000/month in safety audits and certifications plus $50,000 in insurance premiums.
Core approvals
Secure zoning and land use approval
Pull building and trade permits
Pass fire marshal plan review
Get final occupancy approval
Operating permits
Meet health department rules
Pass pool water quality checks
Clear slide and ride inspections
Add ADA access and food permits
Water Park Financial Model
5-Year Financial Projections
100% Editable
Investor-Approved Valuation Models
MAC/PC Compatible, Fully Unlocked
No Accounting Or Financial Knowledge
Confirm what must be ready before admitting guests
Launch readiness checklist
Use this go-live approval checklist to confirm the water park is ready before opening.
1Permits
Zoning and land use approvedCritical
The site must allow water park use before any build or opening work starts.
Building and occupancy permits clearedCritical
Occupancy approval keeps the park legal for guests, staff, and vendors.
Fire marshal and ADA signoffCritical
Crowd flow and access need signoff before guests and staff enter the park.
Health and food permits filedHigh
Food service and water rules need local approval before selling meals and drinks.
Insurance policy is boundCritical
Coverage should be active before build crews, staff, and guests are on site.
2Water safety
Slide inspections signed offCritical
Slides must pass inspection before any guest ride use.
Treatment pumps and filtration workCritical
Water flow and filtration need to hold clean water across operating hours.
Water quality logs are liveCritical
Health checks depend on dated readings for chlorine, pH, and clarity.
Drainage and emergency plans readyHigh
Flooding and evacuation need clear steps before guests arrive.
Safety signage is installedHigh
Guests need visible rules and warning signs at every risk point.
3Ticketing
Ticketing and POS are testedCritical
Guests need a working way to pay before the first open day.
Online booking accepts all pass typesHigh
Day, season, and group booking flow must all work.
Pricing matches Year 1 modelHigh
Year 1 assumes 150,000 day, 15,000 season, and 5,000 group visits.
4Vendors
Vendor contracts are signedHigh
Attraction, food, and service vendors need clear terms before launch.
Attractions and equipment are installedCritical
Slides, pumps, and support gear must be in place before guests enter.
Cabanas, lockers, concessions are readyHigh
These extras drive add-on revenue and reduce opening-day friction.
Security coverage is contractedHigh
Crowd control and overnight protection matter in a high-footfall site.
5Staffing
Opening schedule covers peak demandCritical
The park needs enough people for rides, food, and guest service.
All lifeguards hold current certificationsCritical
Certified coverage is non-negotiable before any water access.
Emergency drills were completedHigh
Staff must know who responds when weather, injury, or evacuation hits.
6Finance
Launch funding covers Month 6 troughCritical
Model bottoms at -$55.383M in Month 6, so funding must cover build-out and ramp.
Construction and capex draws are fundedCritical
The build needs $58.5M of capex before opening.
Year 1 visit mix matches modelHigh
Year 1 assumes 170,000 paid visits across day, season, and group bookings.
Go-live signoff is signedCritical
Final approval should confirm permits, systems, staffing, and cash are ready.
Want the six launch drivers that decide go-live?
1Site Approvals
18–36+ mo
Written approvals keep site control, zoning, access, and utilities clear before major construction starts.
2Design & Build
Build plan
A tied build plan keeps slides, pools, filtration, and guest areas ready for inspection.
3Safety Checks
Final pass
Passed inspections make guest admission legal after water, safety, accessibility, and occupancy checks.
4Staffing
80 staff
Certified zone coverage lets the park open safely with 80 seasonal staff and core leaders.
5Ticketing Flow
Sales live
Tested ticketing, sales, and guest flow keep first revenue moving without slow entry lines.
6Marketing Ramp
15K / 5K
Pre-opening outreach fills early attendance with 15,000 season passes and 5,000 group bookings.
Site Approvals and Entitlements
Site Approvals
Don’t start construction planning until site control, zoning compatibility, and land use approval are in writing. For a water park, the big trap is moving ahead on slides, pools, or utility work before the site can legally support parking, drainage, road access, noise tolerance, and local support.
The readiness signal is simple: a written approval path with no unresolved land use blocker. If entitlement work slips, the whole schedule slips, and major attraction commitments can get ahead of the site. That usually means rework, idle design time, and a launch date that is no longer dependable.
Permit Sequence
Run site due diligence, utility review, access planning, and permit sequencing before you lock the build calendar. One clean rule helps: no long-lead attraction order until the site path is cleared.
Confirm zoning and land use fit.
Map parking, drainage, and road access.
Check utility capacity and tie-in points.
Document noise and neighbor issues.
Track every approval in one master log.
What this hides: entitlement delay is the bottleneck risk, and it can stop the project before construction even starts. If the approval path is unclear, your opening date is still a guess.
1
Design, Construction, and Attraction Installation
Build and Install
This launch driver sets the opening date. A water park cannot open until civil work, pools, slides, pump rooms, filtration, drainage, cabanas, concessions, restrooms, and guest areas all line up with the inspection plan. One late contractor or delayed equipment shipment can hold the whole schedule because the park needs every system ready together on day one.
The clean path is a build plan tied to inspection milestones. Design, engineering, and contractor scheduling have to match the same handoff dates, or the team ends up finished on paper but not ready for testing, water treatment start-up, or final signoff.
Sequence the Critical Path
Lock the order for slide fabrication, utility connections, and water treatment systems before anything is promised publicly. Tie each trade to a dated check-in, so a slip shows up early. If the build plan does not show which item must finish first, the opening date is a guess, not a plan.
Confirm contractor dates in writing.
Track inspection handoffs by zone.
Test utilities before guest areas.
Assign one owner per system.
A late slide or pump-room delay can also push training, stocking, and the final readiness of the 80 seasonal staff planned for Year 1, which means the park can look built but still miss day-one operating capacity.
2
Health, Safety, and Inspections
Health, Safety, and Inspections
The park cannot open until pools, slides, water treatment, lifeguard zones, signage, emergency systems, food areas, accessibility, and occupancy limits pass the right authorities. This is the gate for legal guest admission, so one failed final inspection can push back opening day even if construction is done.
What this means in practice: the team needs clean water quality procedures, emergency drills, signage checks, food service approval, and passed inspection documentation backed by tested operating logs. If any item is missing or not documented, the park may be built but still not allowed to serve guests.
Run the inspection list early
Build the launch plan around the slowest approval path, not the build finish date. Assign one owner for each file set: water tests, drill logs, zone maps, food permit papers, accessibility checks, and occupancy records. Keep every test dated, signed, and easy to hand to inspectors.
Test water quality before final walk-through.
Document emergency drills and staff roles.
Check signage, exits, and lifeguard zones.
Confirm food area approval before opening.
If the final inspection slips, opening slips too, and first-day revenue stops. So keep spare time in the schedule for re-inspection, fixes, and any paperwork the local authority asks for.
3
Lifeguard and Operations Staffing
Lifeguard and Operations Staffing
Certified staff on day one is what makes the park safe and open on schedule. The Year 1 plan needs 80 seasonal staff plus a head lifeguard, operations manager, maintenance supervisor, and guest services supervisor. If certified coverage by zone and shift is missing, the park can’t run full hours cleanly, and launch day becomes a partial opening instead of a real opening.
This role mix covers lifeguards, supervisors, admissions, concessions, maintenance technicians, water quality operators, guest services, and security. Documented training drills matter because they show teams can handle rescues, guest issues, and shift handoffs before the first ticket is sold. The main bottleneck is too few trained people for operating hours, which cuts capacity and slows guest flow.
Build the shift map before hiring floods in
Plan zone-by-zone coverage first, then hire to fill it. Verify every role has a trained primary and backup, and make sure certifications, drill logs, and supervisor sign-offs are filed before opening week. That keeps the staffing plan tied to the actual operating schedule, not just headcount on a spreadsheet.
Map each zone and shift.
Match staff to certified roles.
Document rescue and emergency drills.
Test admissions and guest handoffs.
If training runs late, opening can slip or capacity may need to be capped. Too few trained staff means slower lines, weaker supervision, and more pressure on maintenance and guest service teams, which is exactly when early revenue is most fragile.
4
Ticketing, Revenue Channels, and Guest Experience
Ticketing and Guest Flow
Day-one revenue depends on tested admissions, online ticketing, and clear rules at the gate. If guests can’t buy, scan, park, or store items fast, you don’t just lose sales—you get longer lines, unhappy families, and slower entry on opening day.
Here’s the quick math: the Year 1 model assumes $90 million in day pass revenue, $225 million in season pass revenue, $225,000 in group booking revenue, $30 million in food and beverage, $250,000 in cabanas, and $150,000 in lockers. Those channels need clean checkout, pricing, and guest-service scripts before first admission.
Test Every Sales Lane
Run successful test transactions for every revenue path: ticketing, parking, lockers, cabanas, food and beverage point-of-sale (POS), and group sales. Also test refund steps, sold-out rules, waiver or entry messaging, and how staff handles confused guests. One broken screen can slow the whole front gate.
Do guest flow drills with timed arrivals, parking handoff, scan-in, locker pickup, and cabana check-in. Assign one owner for each lane and document the fallback process if a system fails. The readiness signal is simple: transactions clear, queues move, and staff can keep serving without waiting for fixes.
5
Pre-Opening Marketing and Soft Launch
Pre-Opening Demand Build
For a water park, marketing is a launch control item, not a nice-to-have. The park needs booked attendance before opening week and tested guest messages so day one starts with real traffic, not empty slots. Targets like 15,000 Year 1 season passes and 5,000 Year 1 group bookings only help if the sales path, ticket rules, and arrival details already work.
The risk is pushing presales and promos before inspection confidence. If the opening date slips, you can trigger refunds, complaints, and extra call volume while the park is still fixing operations. That strains cash, staff time, and guest trust right when you need smooth first-week entry.
Sequence Sales After Readiness
Start in layers: local public relations, social media, school and camp outreach, preview events, then soft opening tickets and grand opening promos. Tie each offer to a clear operating gate, like ticketing tested, guest emails working, and the arrival flow ready. One clean rule: sell only what you can serve.
Set presale caps by inspection status.
Test confirmations, reminders, refunds.
Assign one owner for group sales.
Track school and camp lead times.
Match preview size to staffing.
If school and camp outreach starts late, group bookings miss the planning window and opening week demand ramps slower. If soft opening tickets exceed tested capacity, guest service problems show up before the park has a chance to tune entry, parking, and concession flow.
Start with site control, zoning review, and a launch plan that ties approvals to construction and staffing A practical US launch often takes 18–36+ months Use Year 1 demand checks early: 150,000 day passes at $60, 15,000 season passes at $150, and 5,000 group bookings at $45
A seasonal water park can still take 18–36+ months to open because zoning, engineering, pool construction, slide installation, inspections, and lifeguard hiring drive the schedule The operating season may be short, but the approval stack is not Build the timeline backward from inspection readiness, not the desired opening month
Yes, plan lifeguard hiring and certification before opening because staffing coverage is part of operational readiness The model includes a head lifeguard and 80 seasonal staff in Year 1 If certified coverage does not match attractions, capacity, and operating hours, the safer move is to delay guest admission
The biggest delays are land use approvals, building permits, slide installation, filtration systems, utility connections, health department inspections, and seasonal staffing Fixed commitments can make delays painful the model carries $320,000 in monthly fixed expenses That makes permit sequencing and inspection prep a finance issue, not just an operations issue
Start with season pass presales, group bookings, cabana reservations, and opening-week tickets once the opening window is credible The model assumes 15,000 Year 1 season passes at $150 and 5,000 group bookings at $45 Do not oversell before inspection timing, refund rules, capacity limits, and ticketing systems are tested
About the author
Peter Walsh
Launch Planning Specialist
Peter Walsh is a launch planning specialist at Financial Models Lab who helps online business beginners check whether a business idea is financially realistic by breaking down operating cost estimates into clear, practical planning steps. He focuses on opening and running small businesses, and he explains business costs in a helpful, plain-spoken way without unnecessary jargon.
