Food Truck Park Startup Costs: Plan $553K CAPEX Before Reserves
This food truck park startup budget covers site control, site improvements, utility hookups, permits, shared amenities, launch costs, and working capital for a United States food truck park The researched model uses $553,000 in CAPEX during the startup period and a $430,000 minimum cash reserve in Month 13, with $835,000 in first-year revenue and $27,000 in Year 1 EBITDA These are planning assumptions, not guaranteed vendor prices, and they exclude tenant-owned food trucks, tenant food inventory, and tenant equipment
Estimate Startup Costs with Calculator
Startup CAPEX Calculator
Estimates capitalized startup buildout costs only for the park's physical assets, not total funding need.
!
CAPEX scope This calculator covers buildout CAPEX only. It excludes inventory, working capital, opening payroll, deposits, debt service, tenant-owned truck assets, and other operating costs.
Calculate Fuding Needs

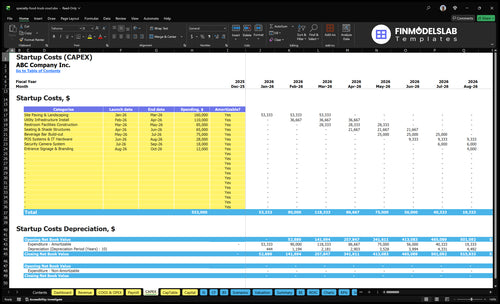

Startup cost summary
This table covers the park's build-out capex and the separate cash reserve needed to open and support Month 13.
Lean, base, and full-service setups change build cost fast. The base plan is the anchor at $553,000 CAPEX, $430,000 cash reserve, and Month 2 breakeven; lean cuts build-out, full adds amenities and staffing.
Lean, base, and full-service food truck park launch costs
Scenario
Lean LaunchLowest cash need
Base LaunchModel anchor
Full LaunchHighest build-out
Launch model
Use a leased-lot setup with fewer truck pads, limited amenities, and portable or rented infrastructure where allowed.
Build the researched $553,000 CAPEX plan with a $430,000 minimum cash reserve and target Month 2 breakeven.
Build a destination-style park with broader amenities, stronger beverage and event infrastructure, larger seating, better lighting, more parking, and higher staffing readiness.
Typical setup
Keep utility upgrades light, use portable restrooms or shared facilities, trim seating and parking, and run a smaller staff.
Use full utility install, permanent restrooms, seating and shade, beverage bar build-out, security, and core staffing.
Add expanded utility scope, permanent restrooms, larger shade and seating, event space, security, and a bigger service team.
Cost drivers
Leased pads
light utilities
portable restrooms
minimal amenities
smaller crew
Property lease
utility infrastructure
restroom build-out
beverage bar
staffing
Expanded utilities
larger seating
event infrastructure
parking build-out
higher staffing
Planning rangeCAPEX only
Below base CAPEXLower cash band
$553,000 CAPEX + $430,000 reserveResearch base
Above base funding bandHighest cash need
Best fit
Best for founders testing demand, land access, and truck traffic before committing to a heavier build.
Best for operators who want the modeled setup and can fund a steady launch with medium complexity.
Best for experienced operators who want a destination site and can fund a bigger, more complex opening.
!
Planning note: Scenario ranges are researched planning assumptions, not exact quotes.
How much money do you need to start a food truck park?
To start a Food Truck Park, plan for at least $983,000: $553,000 in base CAPEX plus $430,000 minimum cash by Month 13, before non-modeled deposits, professional fees, financing costs, and contingency; engagement assumptions should also be checked against What Is The Current Customer Engagement Level At Food Truck Park?. The funding need is larger than construction because it must cover site control, permits, pre-opening work, payroll readiness, marketing, and an operating reserve.
Startup Cash
$553,000 base CAPEX
$430,000 Month 13 cash cushion
$983,000 before added costs
Deposits and fees not modeled
Planning Drivers
Existing utilities lower cash need
Restrooms can raise buildout cost
Pad count drives revenue capacity
$835,000 Year 1 revenue planned
$27,000 Year 1 EBITDA planned
Month 2 breakeven is not guaranteed
45-month payback is a planning output
What hidden costs come with starting a food truck park?
A Food Truck Park has hidden costs before day one, and they can be bigger than founders expect. The first hit is permits and setup, plus a cash buffer; for owner-side context, see How Much Does The Owner Of Food Truck Park Typically Make? because the fixed monthly load is already heavy: $15,000 lease, $3,800 utilities, $2,200 maintenance, $1,300 insurance, $1,900 security, $600 software, $350 admin supplies, and $850 bar equipment lease. Year 1 payroll is $285,000, and cash pressure can reach $430,000 by Month 13.
Pre-opening costs
Zoning reviews and site plans
Environmental due diligence and surveys
Health department and fire marshal review
Signage permits, waste, grease, marketing
Monthly cash load
$15,000 property lease
$3,800 utilities and $2,200 maintenance
$1,300 insurance and $1,900 security
$285,000 Year 1 payroll and $430,000 Month 13 cash need
What drives the cost of a food truck park?
For a Food Truck Park, the cost is driven by site condition and municipal rules, not generic startup overhead. The biggest modeled items are $160,000 for paving and landscaping, $110,000 for utility infrastructure, $85,000 for restrooms, $65,000 for seating and shade, and $75,000 for the beverage bar. A lot already approved for outdoor food service is cheaper to open than a raw parcel because grading, drainage, truck circulation, parking, lighting, fencing, accessibility, electrical capacity, water, wastewater, grease, trash, and fire-safety work can already be partly done.
Site work drives cost
$160,000 paving and landscaping
Grading and drainage first
Truck circulation needs room
Parking and lighting add cost
Municipal rules add spend
$110,000 utility infrastructure
$85,000 restroom facilities
$65,000 seating and shade
$75,000 beverage bar build-out
Key Takeaways
Site control costs start before buildout and rent.
Buildout CAPEX begins with paving, drainage, and access.
Utilities and restrooms can swing the budget hardest.
Permits and launch costs need user-entered pricing.
Food Truck Park Core Five Startup Costs
Site Control and Location Readiness Startup Expense
Lease Cash Up Front
Start with site control, not buildout. The lease assumption is $15,000 per month from Month 1 to Month 60, so Year 1 rent is $180,000. Show the deposit, first rent, broker fee, and legal review as separate startup cash items, because those hit before any paving, utility work, or restroom spend.
Due Diligence Checks
Location readiness means proving the site works for trucks and guests. Budget for survey, environmental review, zoning fit, and legal review as separate line items. The inputs are simple: vendor quotes, attorney hours, and any city review timeline. One weak report can delay opening, so this work belongs before improvement CAPEX starts.
Check zoning before signing.
Price survey and environmental reports.
Track broker and legal fees.
Access And Use Fit
Test the site like a customer would. Confirm ingress and egress, parking visibility, neighboring use conflicts, and utility availability before you commit. These issues do not sit in buildout CAPEX; they sit in site-control risk. If trucks cannot enter cleanly or guests cannot see parking, the location can fail even with strong demand.
Verify truck turning space.
Confirm guest parking sightlines.
Ask about nearby noise or use conflicts.
Landlord Buildout Help
Ask whether the landlord funds any paving, utility upgrades, restrooms, or signage. That keeps site-control costs separate from improvement CAPEX and stops you from double-counting. If the landlord pays for any of it, your upfront cash need falls fast; if not, those items stay in the startup budget and need their own quotes.
Permits, Zoning, and Professional Services Startup Expense
Approval Scope
This line covers zoning approvals, any conditional use review, site plan approval, health department and fire marshal review, signage permits, business licenses, legal and accounting setup, plus architect, engineer, and plan revision fees. City, county, and state rules vary, so treat it as a quoted or user-entered cost, not a fixed number.
How To Price It
Build the estimate from required filings, consultant quotes, and review cycles. Ask for separate bids from the architect and engineer, then add permit, license, and revision fees by jurisdiction. Keep this outside site work: the $160,000 paving budget, $110,000 utility install, and $85,000 restrooms are separate CAPEX lines.
Use city fee schedules
Price revision rounds upfront
Split each jurisdiction
Timing Risk
This cost is really a calendar risk. CAPEX starts in Month 1 and runs through Month 10, so a slow zoning or fire sign-off can delay paving, utilities, and opening work. If approvals drag, your rent, design, and contractor timeline can keep running while the build is paused.
Reduce Delays
Start with a pre-application check, then bundle drawings so zoning, health, fire, and signage reviewers see the same plan set. Ask early whether the site needs conditional use review or a simple permit path. The win is speed, not cheap shortcuts, because one extra revision cycle can push the whole opening schedule.
Amenities, Technology, Signage, and Launch Startup Expense
Launch Cash Load
This category is a fixed early cash block: the listed CAPEX totals $198,000 before site control, and Year 1 staffing adds $285,000. Marketing runs at 30% of revenue, and event cleaning at 10%, so opening date and sales pace matter.
Guest-Facing Build
Build the guest-facing layer with $65,000 seating and shade, a $75,000 beverage bar, $28,000 POS and IT hardware, $18,000 cameras, and $12,000 entrance signage. Price it from vendor quotes, counts, and install scope, not a lump estimate.
Use separate quotes for each line
Track seats, devices, and signs
Keep install scope in writing
Control The Spend
Trim risk by matching spend to opening flow: phase seating, standardize hardware, and keep the bar, cameras, and signs on one bid schedule. Don’t fold these items into truck equipment CAPEX; this is park-level infrastructure, and the mistake is buying extras before guest flow works.
Phase work by opening date
Bundle install bids where possible
Protect circulation and payment flow
Launch Readiness
Non-CAPEX launch items still move cash: website, booking tools, opening marketing, staff readiness, cleaning setup, waste stations, and guest flow planning. Treat them as opening costs, then layer in $285,000 Year 1 payroll plus revenue-based marketing at 30% and event cleaning at 10%.
Utility Infrastructure and Code Compliance Startup Expense
Utility Buildout
Plan for $110,000 in utility infrastructure from Month 2 through Month 4. This should cover electrical capacity, truck hookups, water access, wastewater handling, trash service, grease control, fire safety, utility-company approval, and municipal inspection timing. Build the estimate by line item so you can see what drives the spend.
Split the Cost
The right estimate breaks this into electrical, water, sewer, waste, and fire-safety buckets, then layers in quotes for approvals and inspections. $85,000 more is needed for restroom facilities from Month 3 through Month 5 if park-owned restrooms are required or chosen.
Separate utility scopes by trade
Ask for approval timing in writing
Price restrooms as a second phase
Control the Spend
Utilities can move the startup budget more than furniture or signage, so push vendors for exact quotes before work starts. Here’s the quick rule: don’t bundle everything into one lump sum. Get separate bids for electrical, water, sewer, waste, and fire-safety work, then compare them against the restroom package.
Lock scope before digging starts
Use phased billing by milestone
Check inspection dates early
Timing Risk
What this estimate hides is delay risk: utility-company approval and municipal inspections can stretch the Month 2 to Month 5 window, which pushes both cash need and opening date. If approvals slip, the site may be ready on paper but not usable in practice.
Site Improvements and Buildout Startup Expense
Site Work Budget
The biggest physical site item is usually site paving and landscaping, with a base of $160,000 across Months 1 through 3. That covers grading, gravel or asphalt, drainage, truck circulation, customer parking, lighting, fencing, accessibility, landscaping, and weather durability. It is site-dependent, not a fixed build price.
Cost Inputs
Here’s the quick math: estimate by lot size, truck pad count, parking count, stormwater rules, slope, soil condition, and whether the site already supports commercial traffic. One lot can need only basic surfacing, while another needs full drainage and traffic control. This line should sit in the core buildout budget, not in lease or operating rent.
Count truck pads first
Price drainage separately
Check existing commercial access
Control the Scope
Do not price this like generic asphalt work. Get civil and site bids early, then compare what each quote includes for drainage, lighting, fencing, and accessibility. The main risk is underbuilding circulation or stormwater fixes and paying twice later. A simple rule: match the lot to truck flow first, then add parking and landscaping.
Price drainage before pavement
Avoid overbuilding unused parking
Verify site access up front
Month 1-3 Cash Need
Because this spend lands early, it needs cash before opening revenue starts. Keep the $160,000 buildout separate from lease deposits, monthly rent, and utility work so you can see what is true site CAPEX and what depends on the landlord or the city.
